Week 75 | 74 | 73 | 72 | 71 | MAR | 70 | 69 | 68 | 67 | 66 | 65 | 64 | 63 | JAN 2017 | 62 | 61 | 60 | 59 | 58 | 57 | 56 | 55 | NOV | 54 | 53 | 52 | 51 | 50 | 49 | 48 | 47 | 46 | SEP | 45 | 44 | 43 | 42 | 41 | 40 | 39 | 38 | JUL | 37 | 36 | 35 | 34 | 33 | 32 | 31 | 30 | MAY | 29 | 28 | 27 | 26 | 25 | 24 | 23 | 22 | 21 | MAR | 20 | 19 | 18 | 17 | 16 | 15 | 14 | 13 | JAN 2016 | 12 | 11 | 10 | 9 | 8 | 7 | 6 | 5 | NOV | 4 | 3 | 1&2 | SEP 26 2015 | Archives

Search this site Full results

March 2017

Monday Tuesday Wednesday Thursday Friday Saturday Sunday
(27) [8] PP5b Week 71 for complete view. Calendar abbreviates.

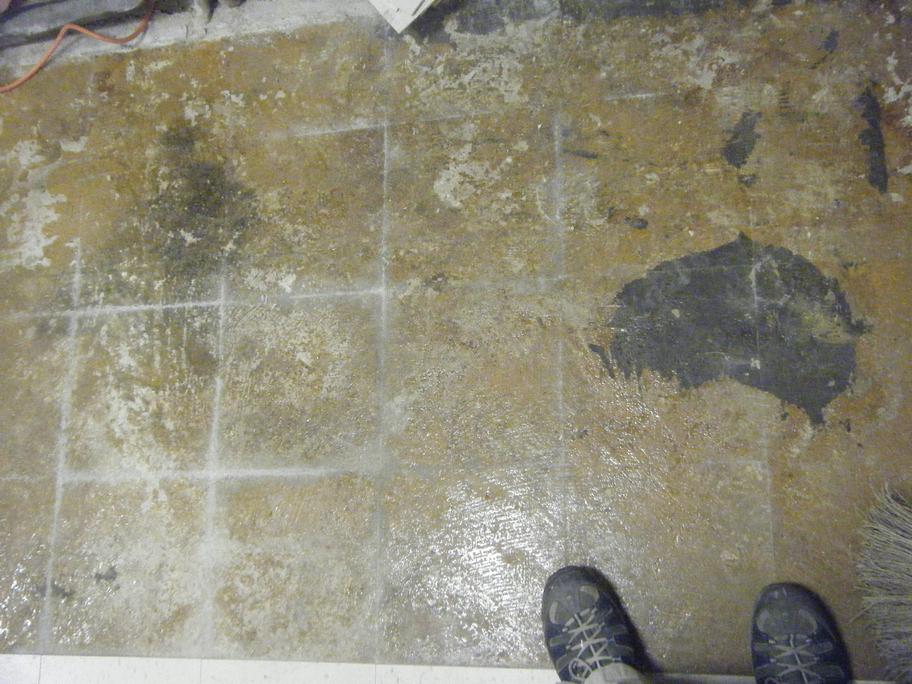

JAG School 110A women's lounge renovation. Day 6.

(28) [5 from Sat] Sick Day

JAG School 110A women's lounge renovation. Day 7.

1 [8] Prep Graduation 2017. Graduation 2016 Week 32.

2nd AIM class.

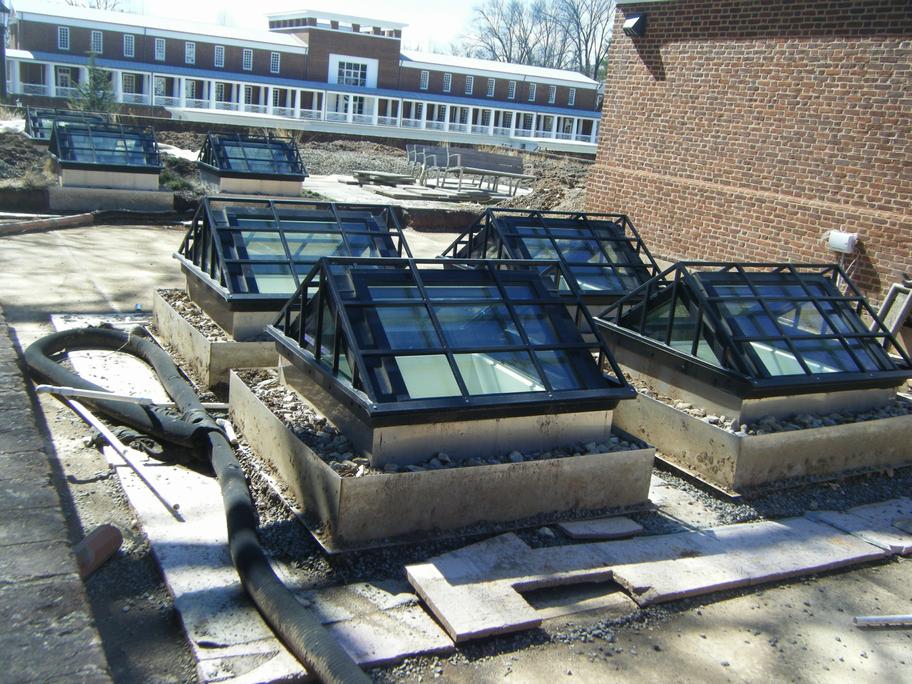

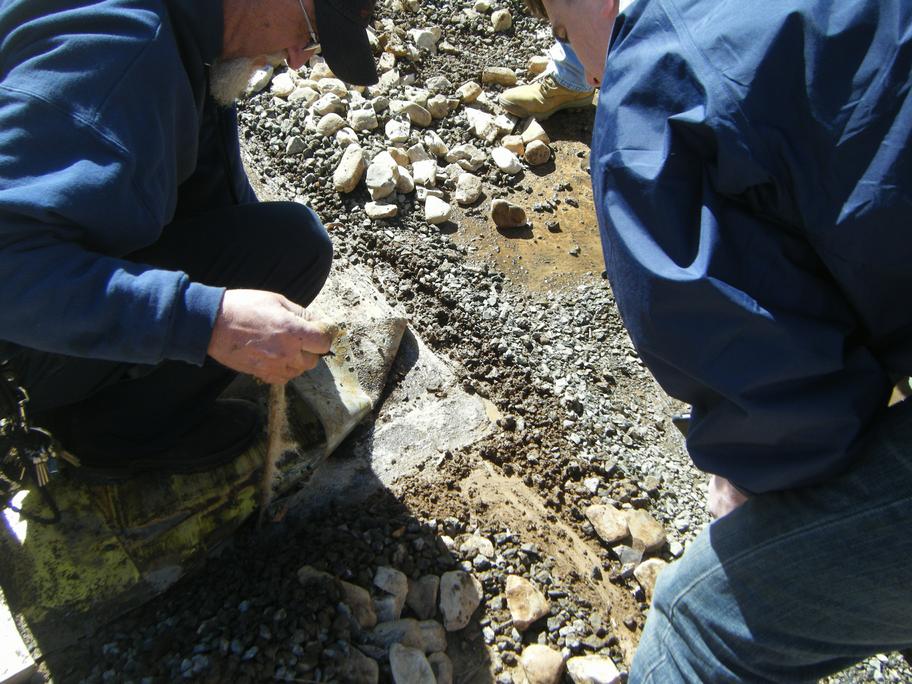

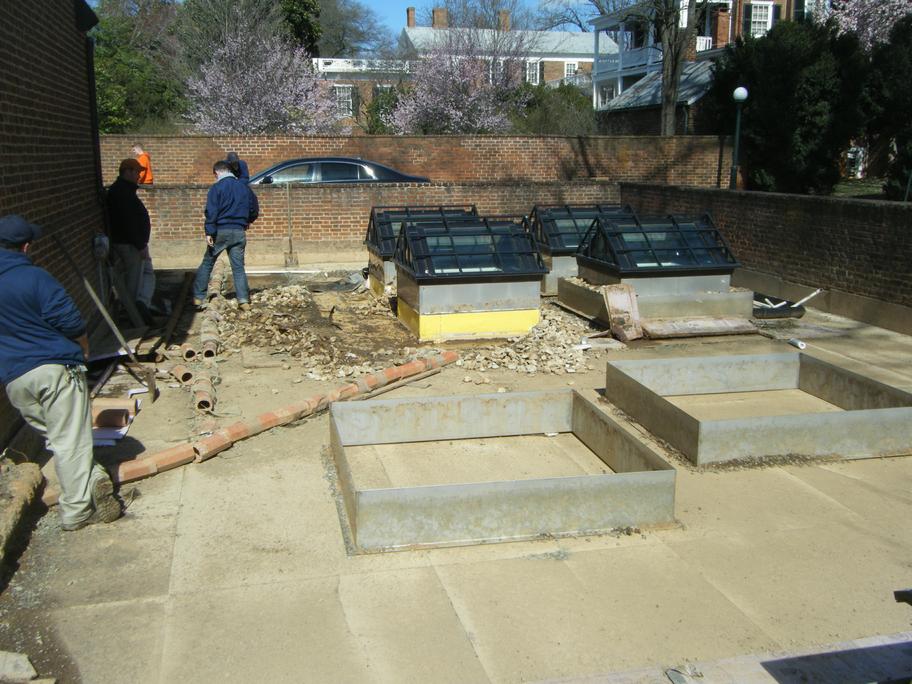

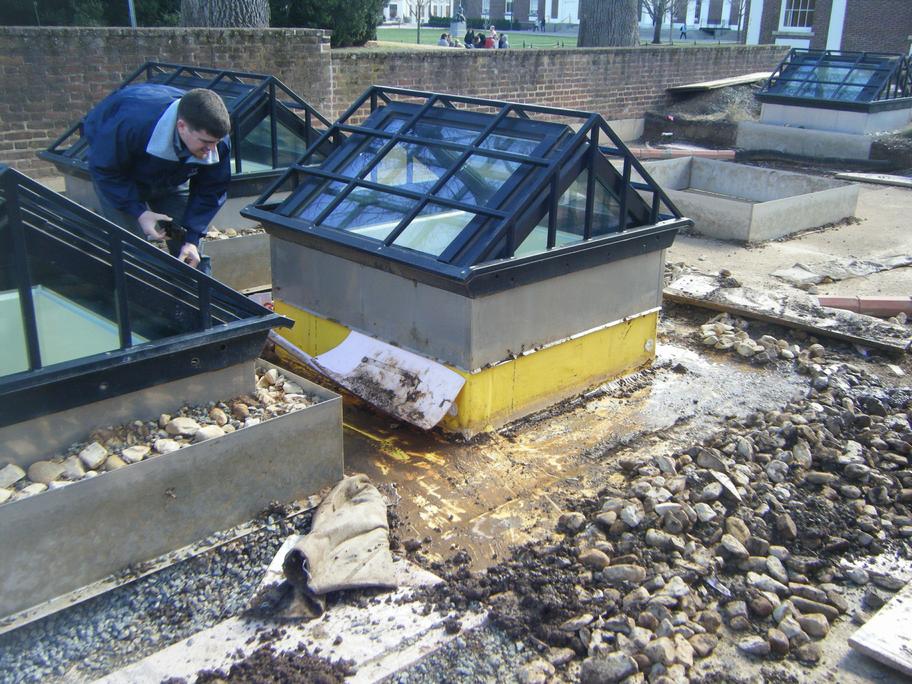

2 [8] Garrett Hall. Investigate roof leak at skylight.

Prep Graduation 2017.

3 [8] Prep Graduation 2017.

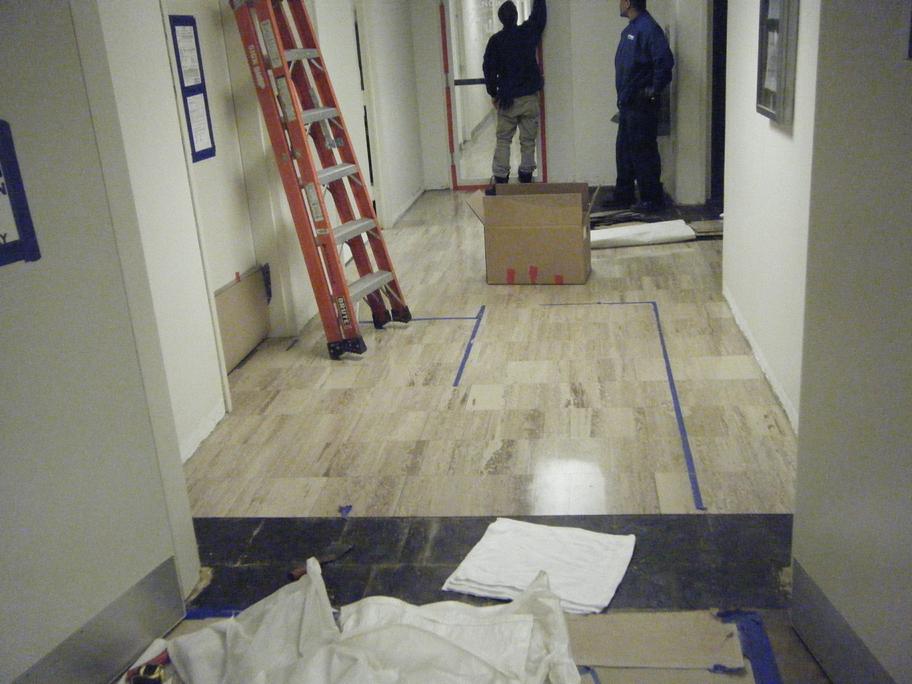

4 [5 to Tue] JAG School hallway at elevator and NCO Academy. Floor tile / Mastic. Day 1.
5 [PP5a 1.5 Comp. PP5b 3 UL. PP5 Leave 161–3=158. Comp 2.5–1.5=1.]
Timesheets
Monday Tuesday Wednesday Thursday Friday Saturday Sunday
6 [8] PP6a Week 72 for complete photos and entries.

JAG School hallway at elevator and NCO Academy. Room B017. Day 2.

7 [8+1] Staff appreciation breakfast.

Alderman Library.

JAG School hallway at elevator and NCO Academy. B017. Day 3.

8 [8] JAG School hallway at elevator and NCO Academy. B017. Day 4.
9 [8+1] Mary Munford House C002 (2). Exploratory hole in asbestos plaster ceiling.

JAG School hallway at elevator and NCO Academy (6+1). B017. Day 5. The heavy duty ripper-stripper worked.

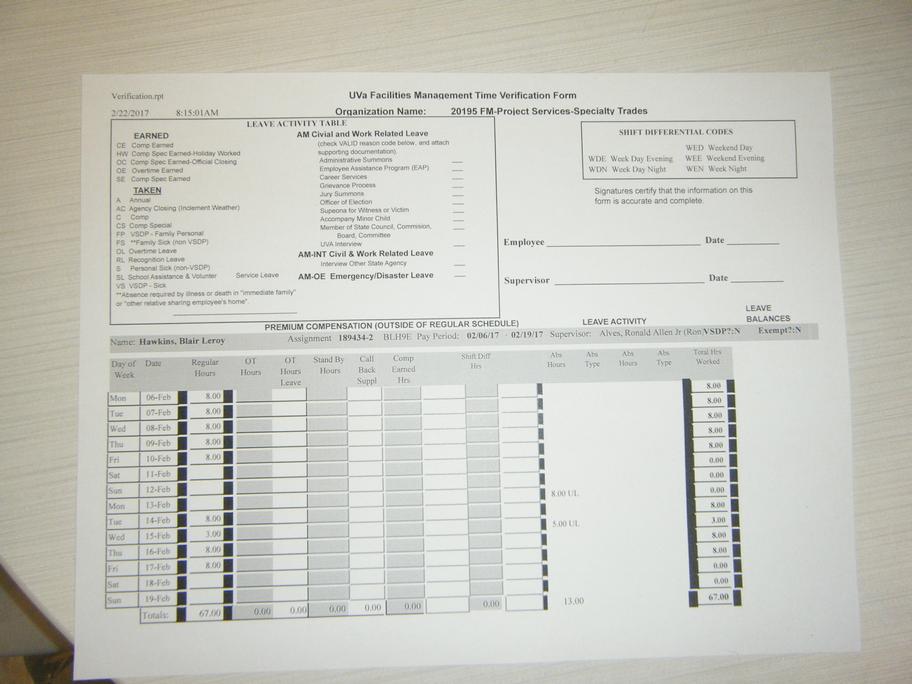

10 [5+8Hol] Payday Pay Period 5.

Holiday Spring Break.

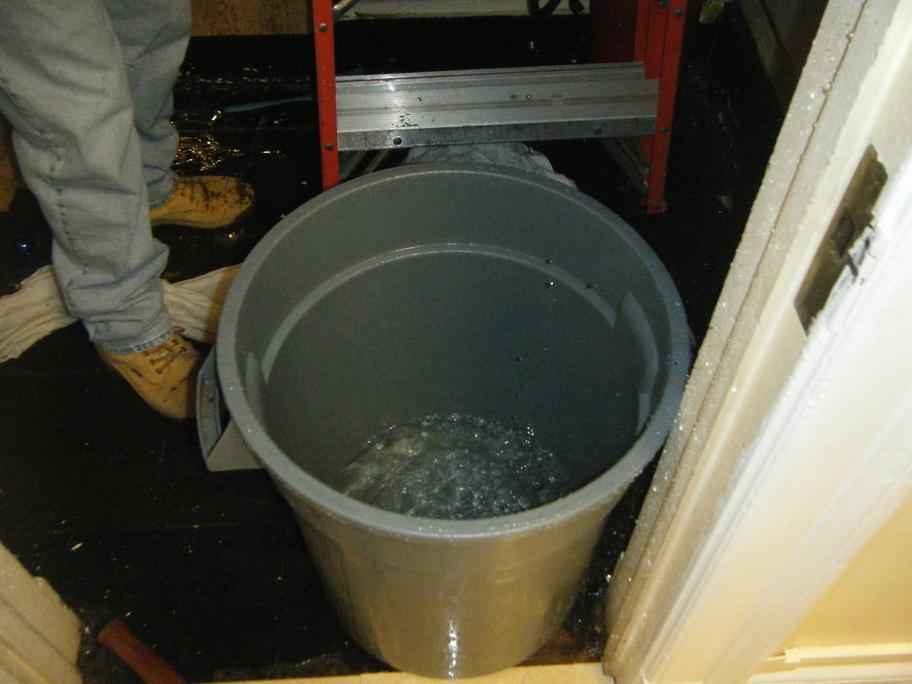

Zehmer 118. Asbestos ceiling and HVAC repair cancelled last minute. Meeting on Thu 2-2 and work done 2 Saturdays ago. Rescheduled possibly Tuesday.

JAG School hallway at elevator and NCO Academy. B017. Day 6. Unload cargo van.

Gilmer 178D vivarium. Asbestos counter-tops.

11 12 [PP6a 40 + 5 + 2 OT. ]

Procedure Floor Tile & Mastic
SDS Chemsafe 100C Mastic Remover. Fire Diamond 1-2-0 PPE H. Petroleum product.

Job Hazard Analysis describes step-by-step process, aligns with Training page of chemicals and safety data sheets. Negative air for dust phase & chemical phase. Hands&knees only if area less than 30 square feet (small apartment bathroom).

PPE H minimum.

  • Splash Goggles
  • Gloves cover forearms
  • Synthetic Apron
  • Vapor Respirator
Monday Tuesday Wednesday Thursday Friday Saturday Sunday
13 [8] PP6b Week 73 view with all photos and entries.

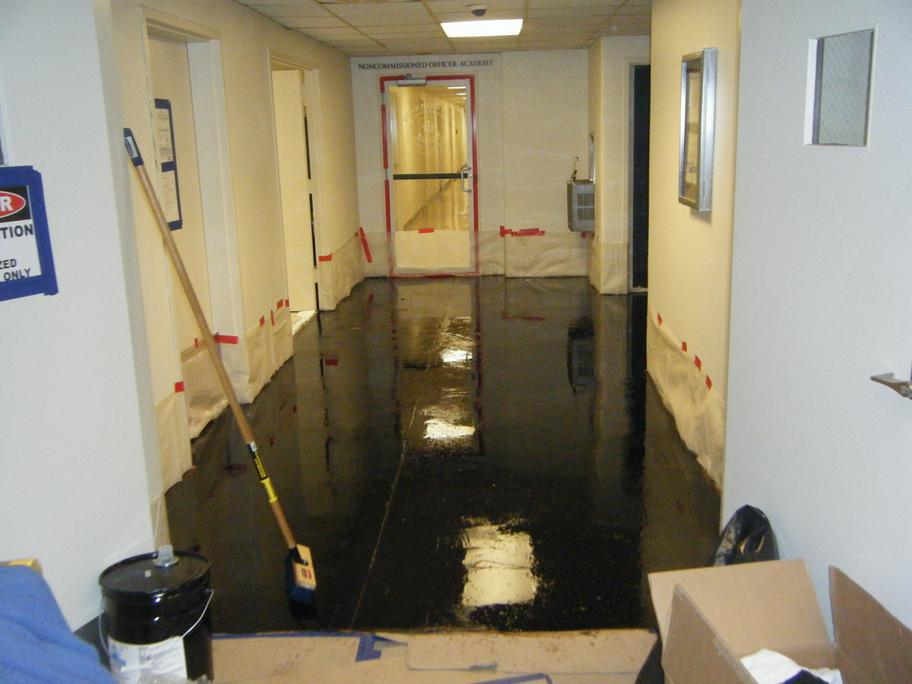

JAG School hallway at elevator and NCO Academy. Day 7. (9 photos)

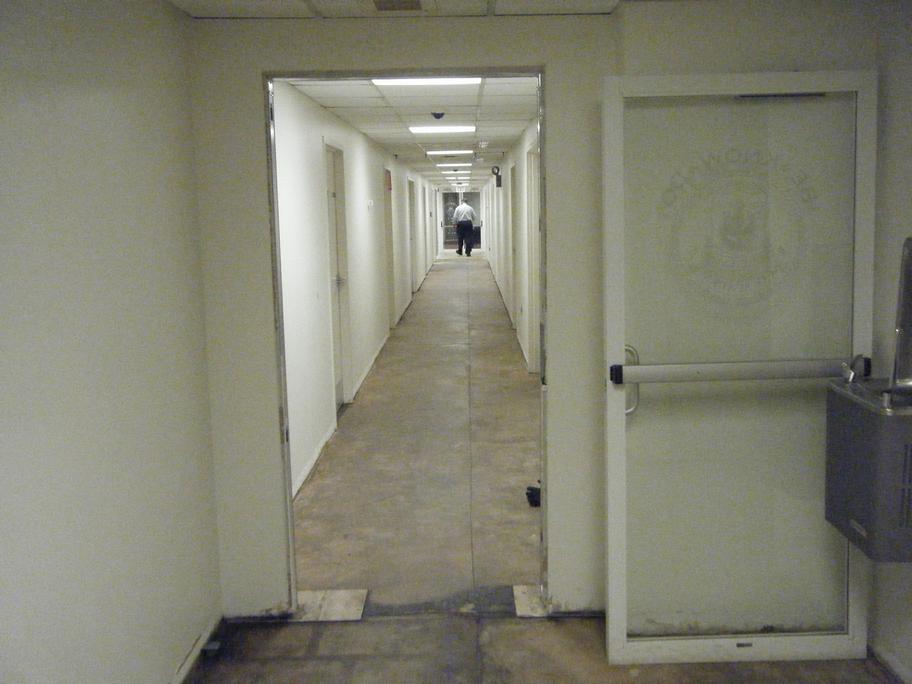

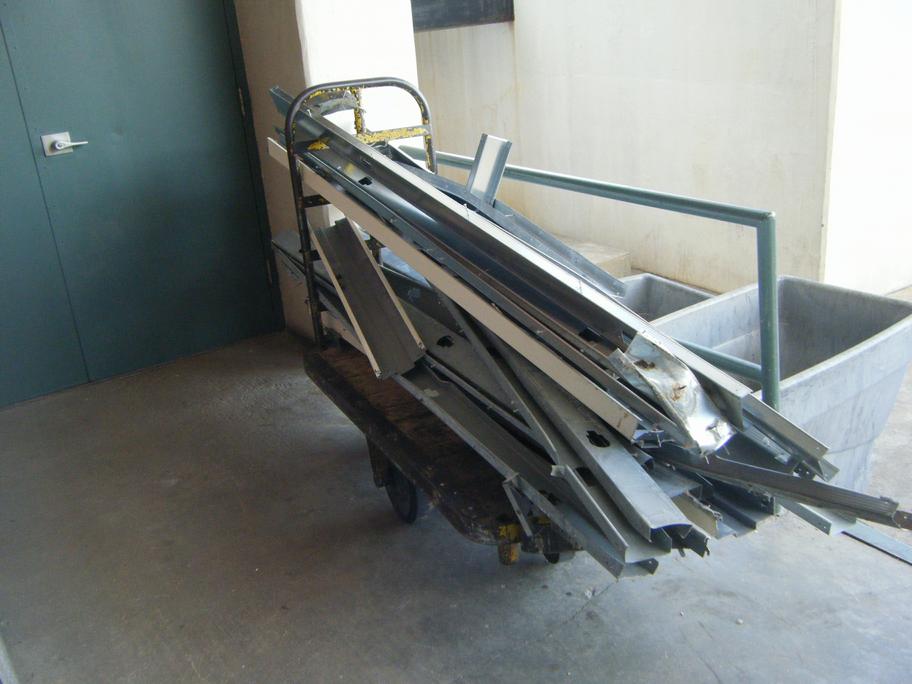

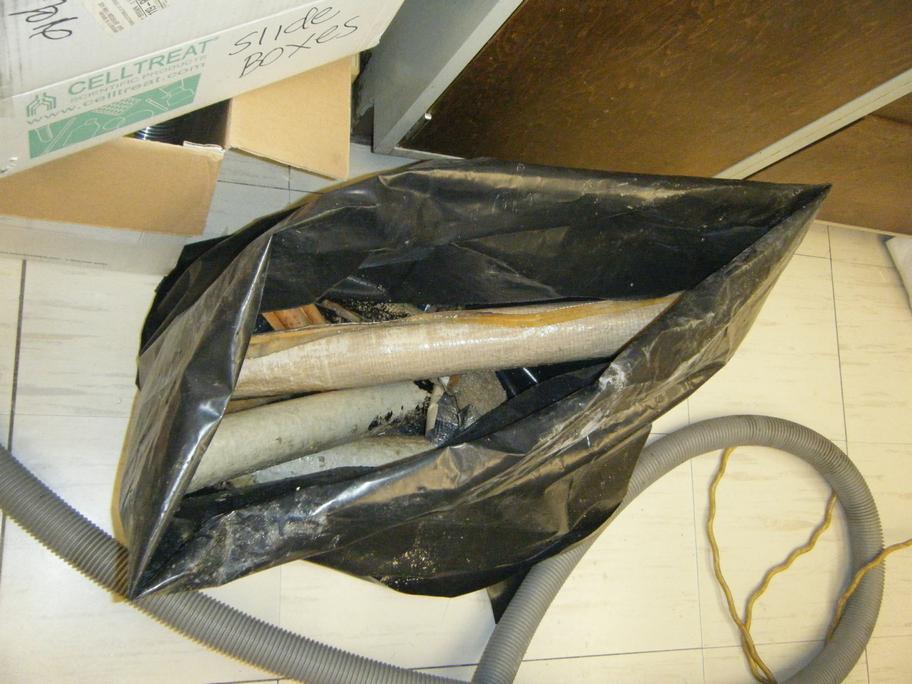

Old Med School 1766A. To be scheduled. Access 1768 to 1766 to 1766A. Remove asbestos pipe insulation connecting Red Tank to air handlers both sides. (8 photos)

Old Med School hallway outside 1768. Status photos(5).

14 [8] Snow Duty 6 a.m.(1) Dusting of snow/ice didn't stick on roads/sidewalks. Look back at Jan 2016 snowstorm.

Post manifest on asbestos dumpster full for replacement. Magnetic signs behind van seat.

JAG School hallway at elevator and NCO Academy. Calendar Day 8. Unload cargo van. Haul away remaining equipment.

Zehmer 118. Meeting of management. Last on Fri 3-10-2017 cancelled at last minute.

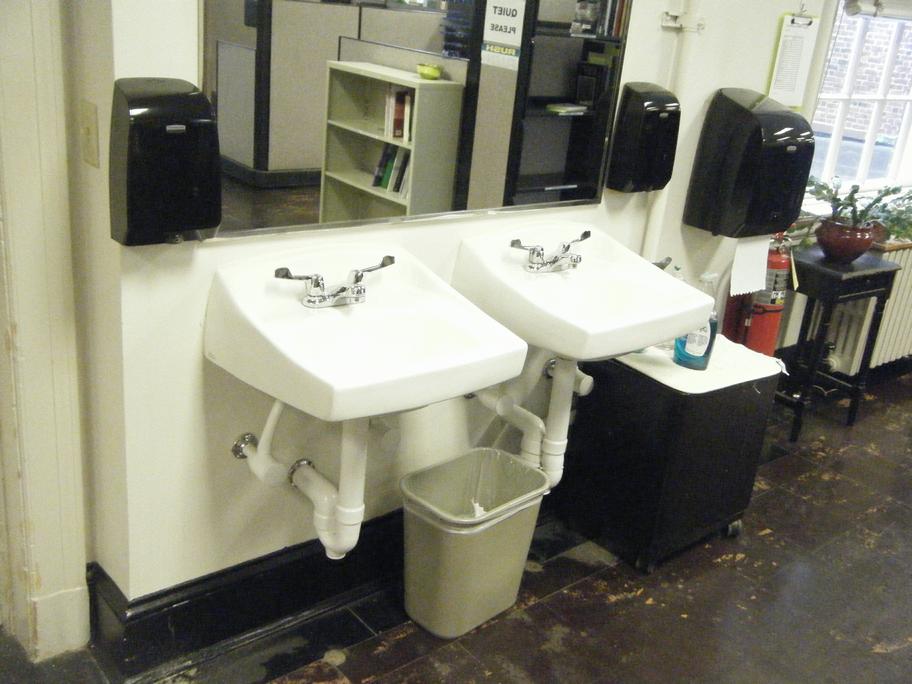

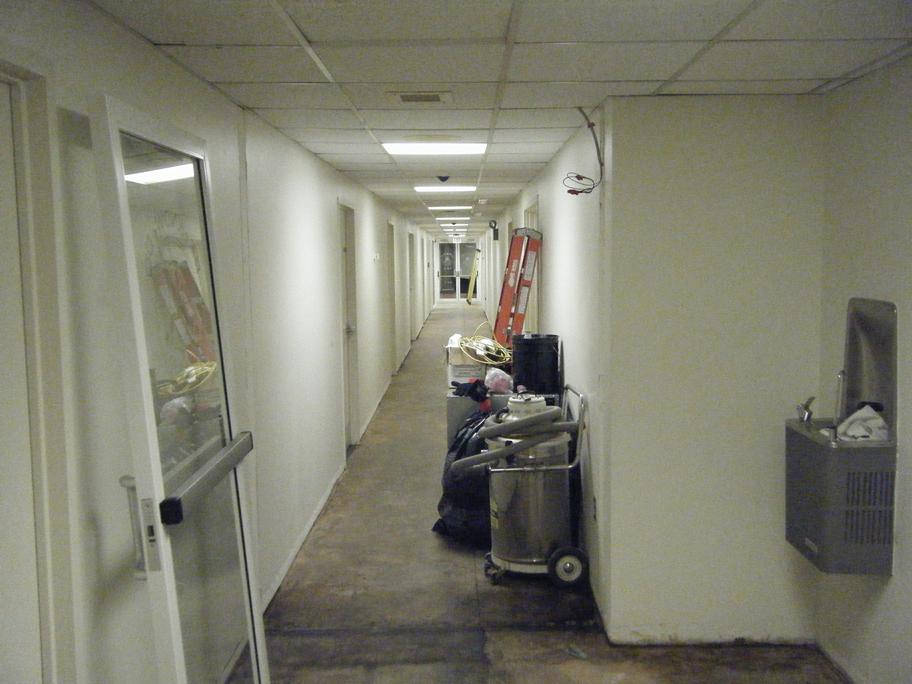

Alderman Library 2nd floor west wing. Behind the sinks, remove enough asbestos pipe insulation for plumber. Around the corner to the right is Dirt Room last on Thu 9-22 and Tue 9-6 and Tue 5-31-2016.

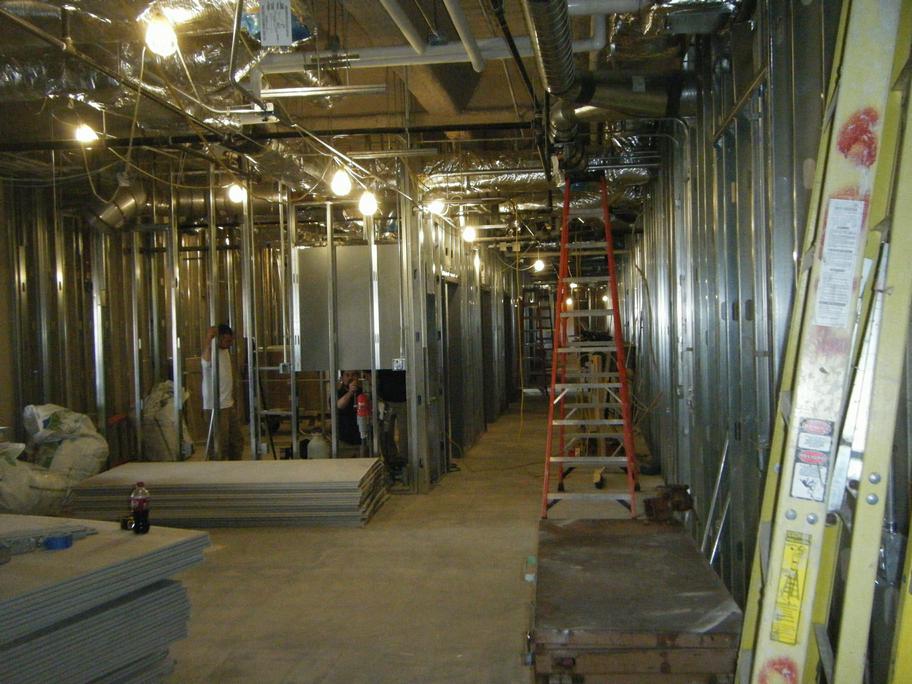

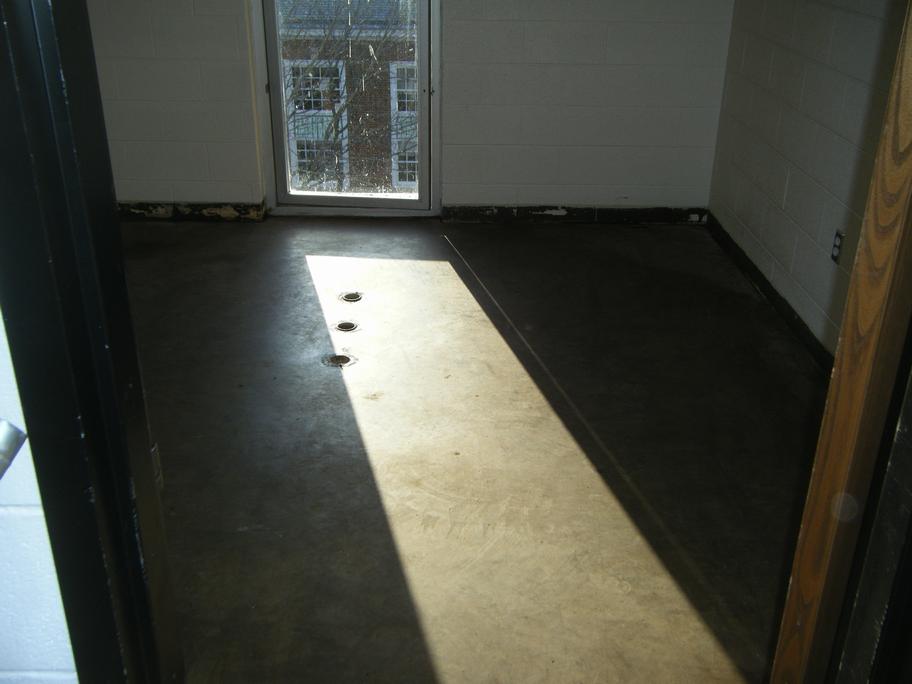

Mechanical Engineering 306. Asbestos vynil floor tile, asbestos mastic, asbestos baseboard. Day 1. (8 photos)

15 [] Sick Day

Mechanical Engineering 306. Day 2.

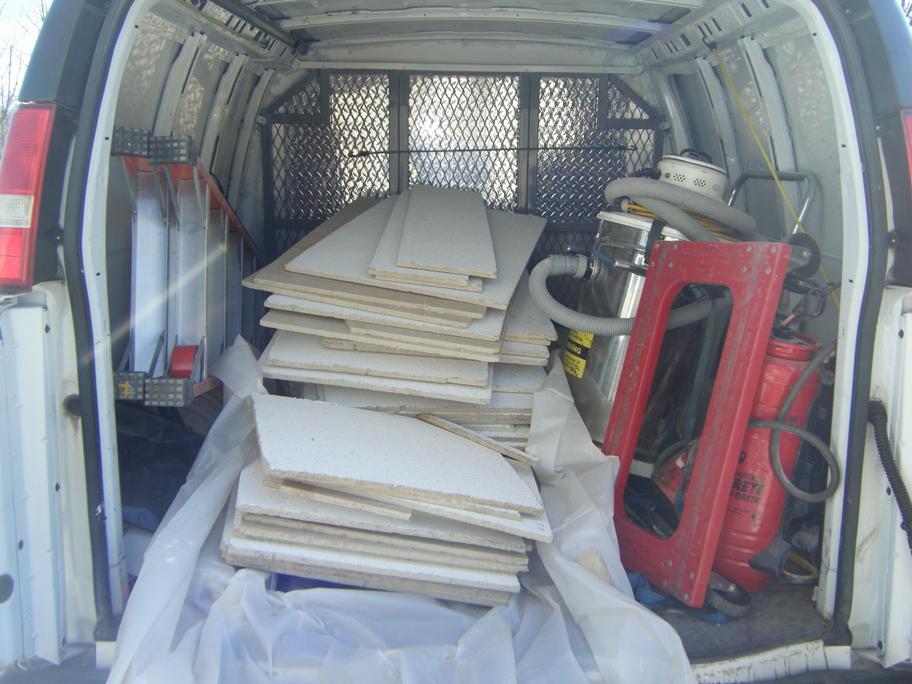

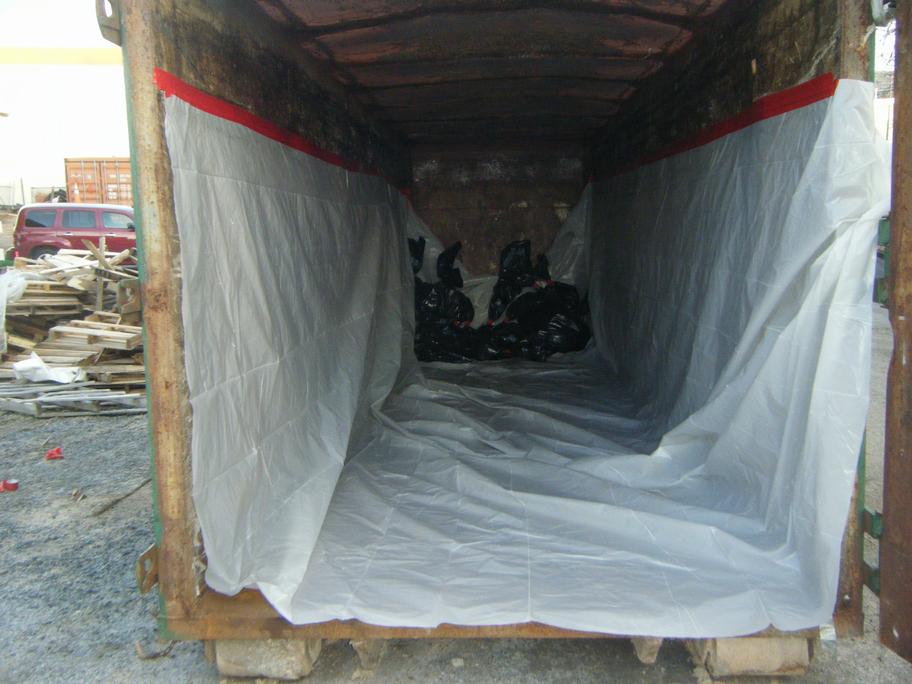

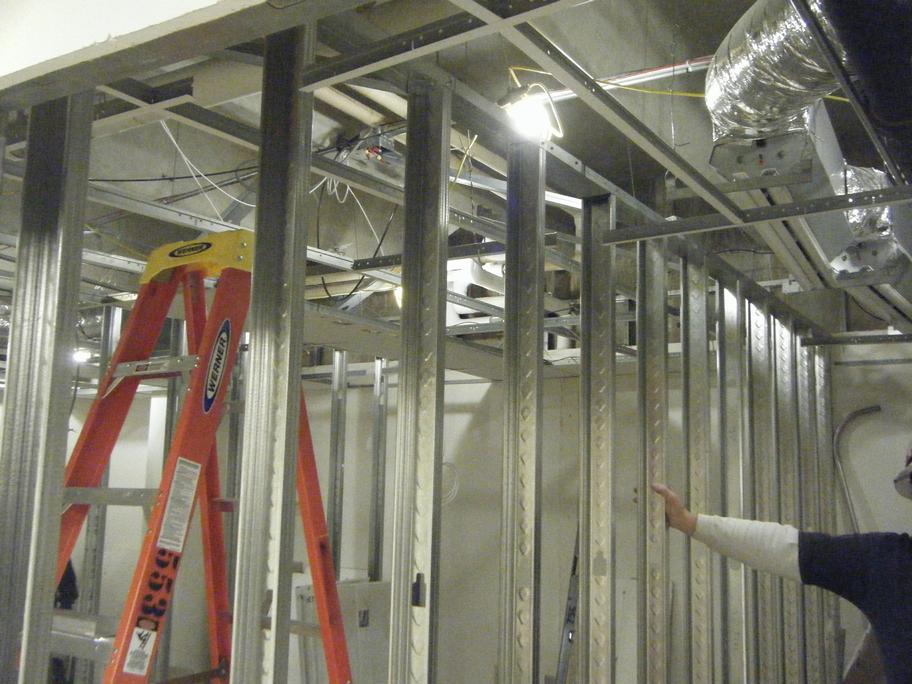

16 [8] Mechanical Engineering 306(2 hours). Day 3. Line empty asbestos dumpster with plastic. Unload disposal bags of floor tile and mastic. Remove all equipment from 306.

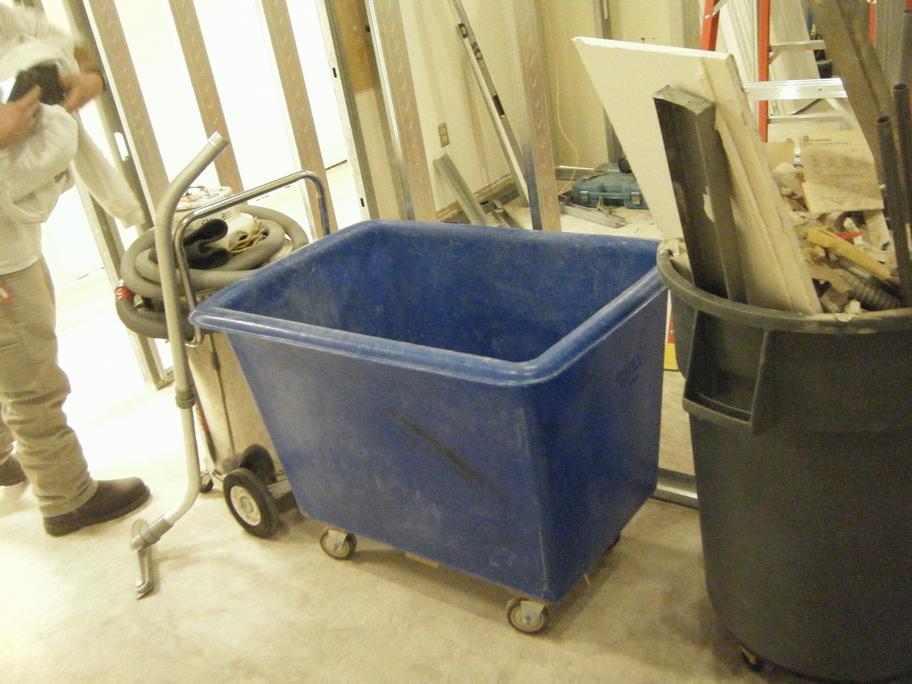

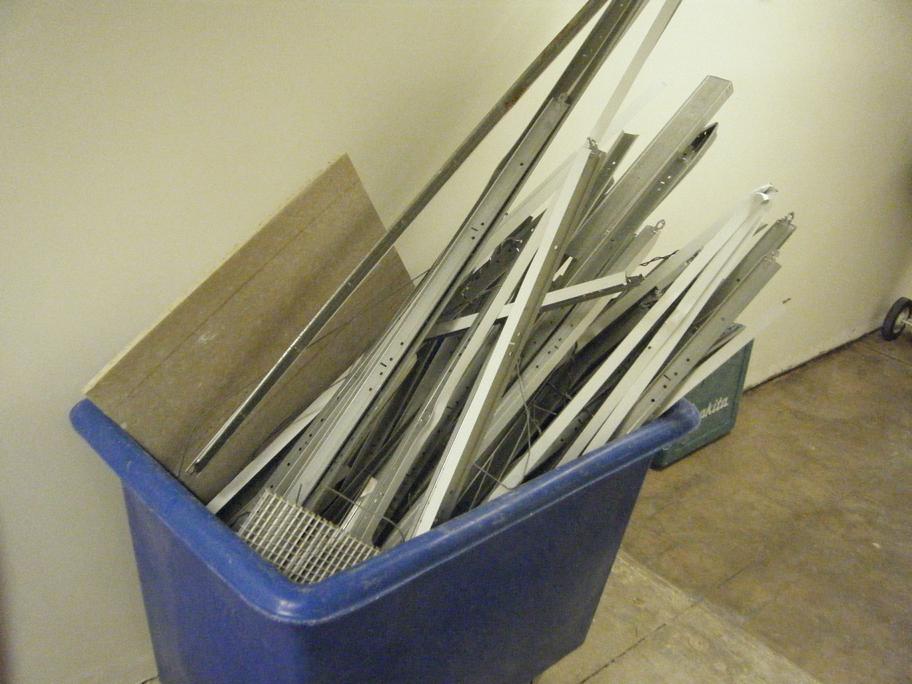

JAG School hallway at elevator and NCO Academy(6 hours). B017. Day 9. Task was added to take down non-asbestos ceiling tiles and the ceiling grid. No equipment left at JAG.

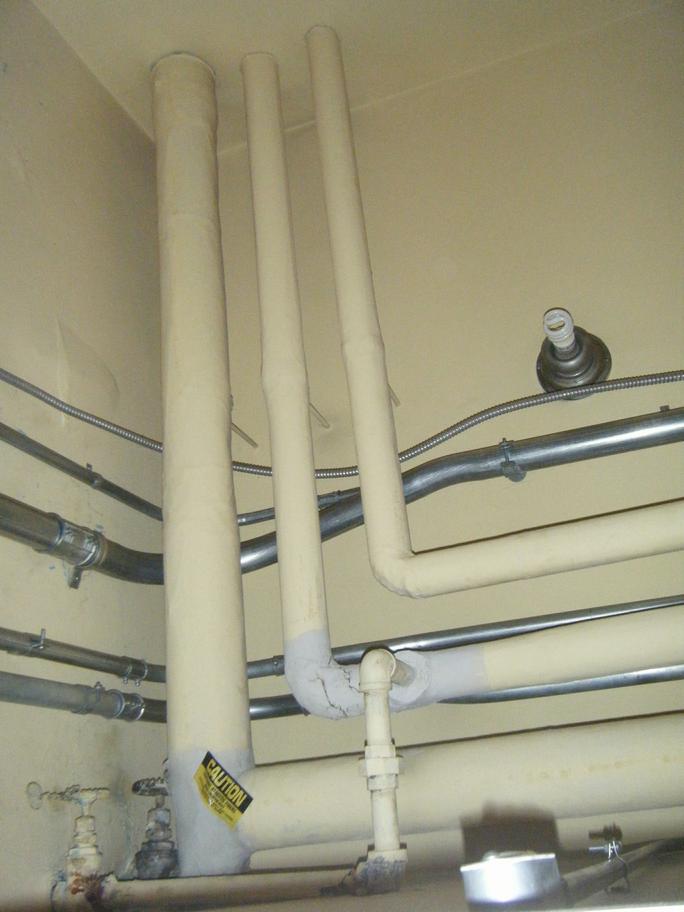

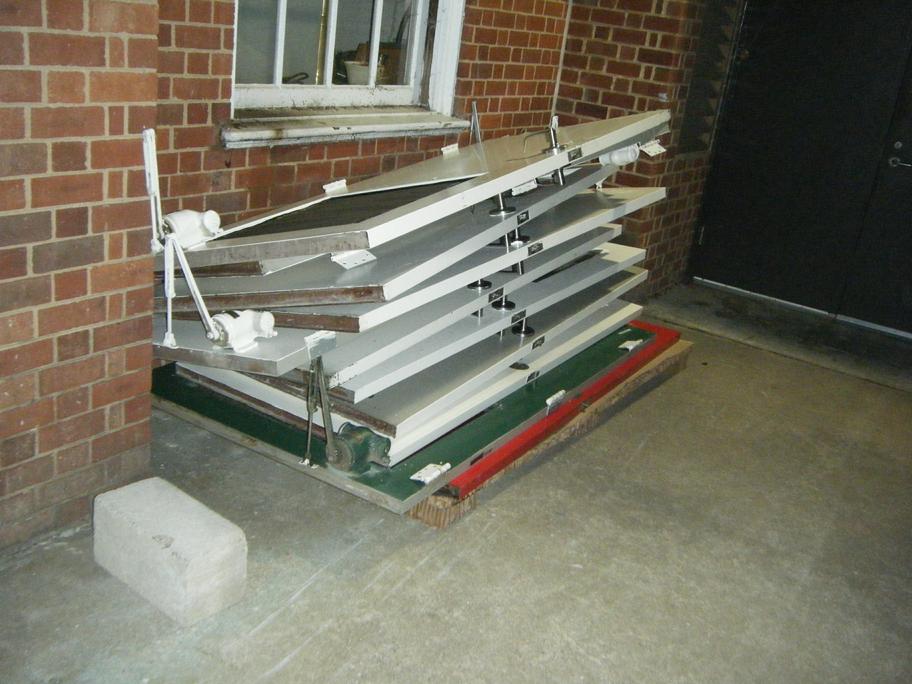

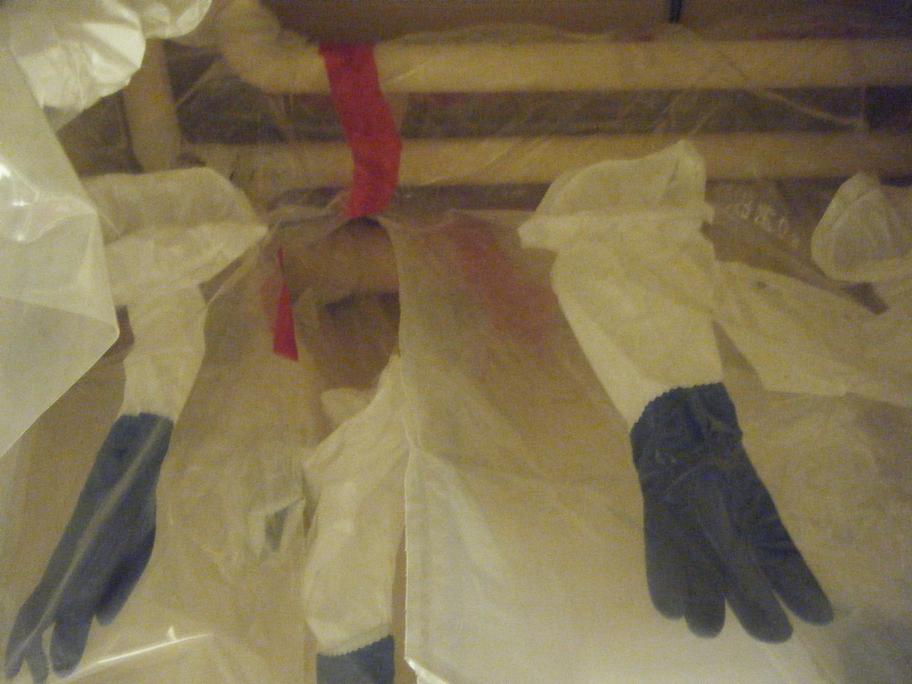

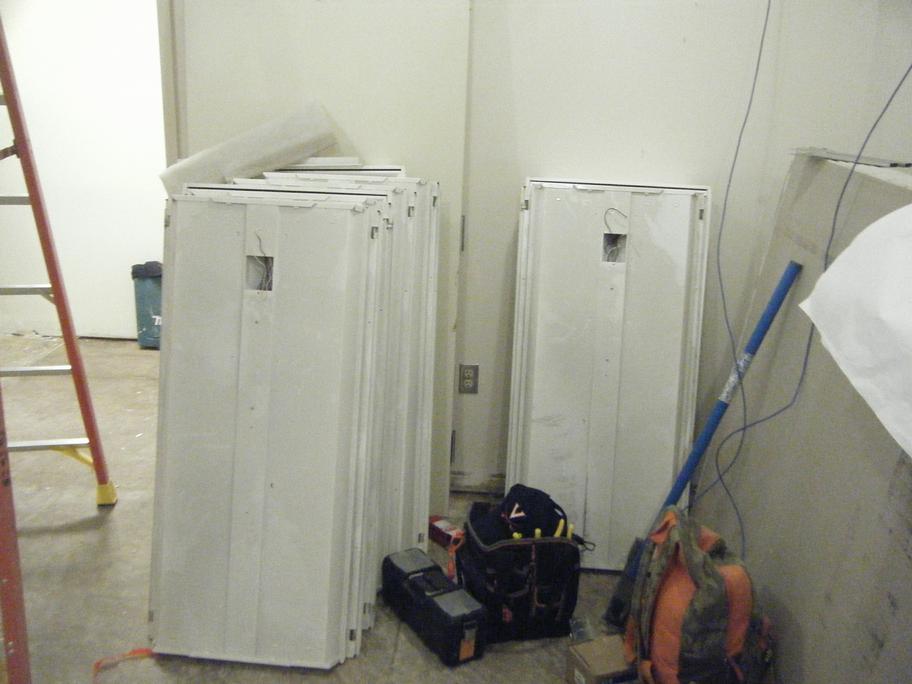

17 [8] 6 a.m. 11 Asbestos doors on Physics loading dock. Haul away to asbestos dumpster at Fontana.

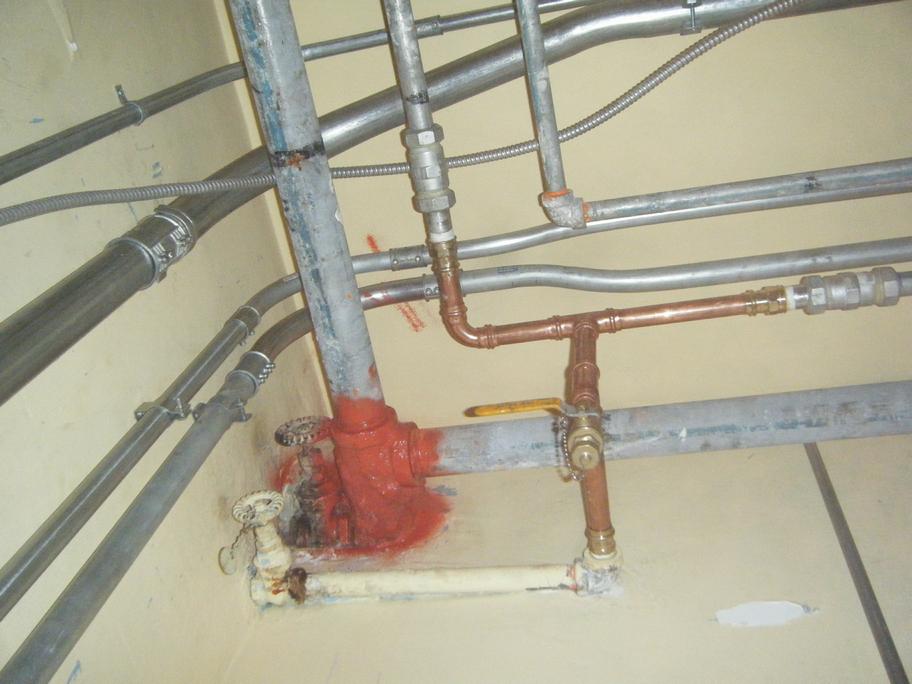

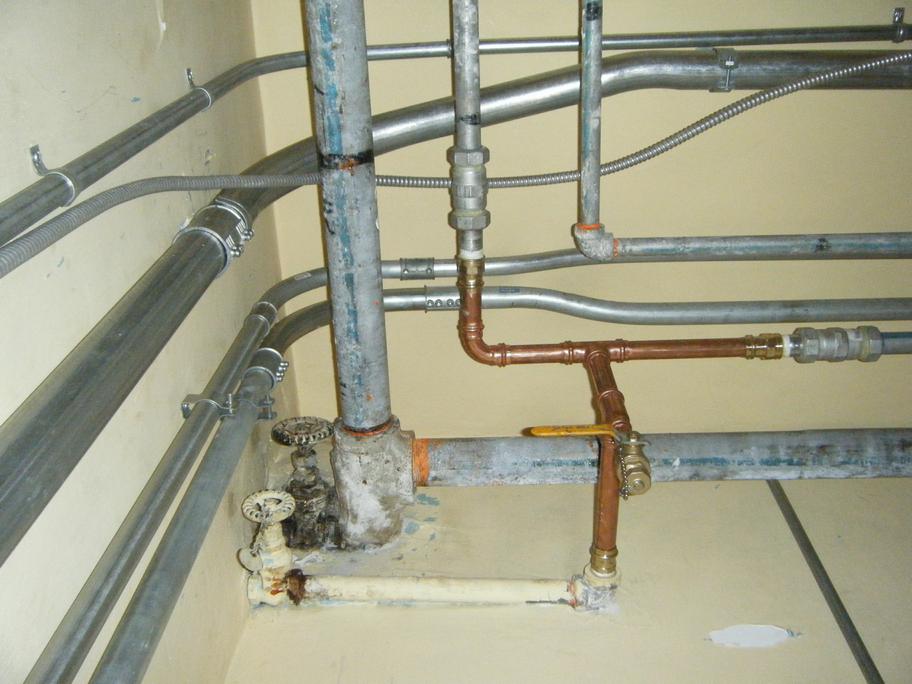

Alderman Library 1st floor kitchen utility room.(3-16 put on my calendar) 8 glovebags for asbestos pipe insulation, 3 lines, 6 wall penetrations. Major electric lines and boxes. Shelves full of kitchen and paper junk. Hot water pipe sprung a major leak at T-intersection. Plumbers shut down the water line. Asbestos safety inspector was on-site monitoring. Stakeholders unaware the work would be today have all been notified. 4 glovebags removed on 2 small lines. 4 glovebags remain on single large line. Also crew was not prepared with necessary tools outlined in Govebag Procedure. Need a contents list and storage box to stay in work van or be able to put back in the van.

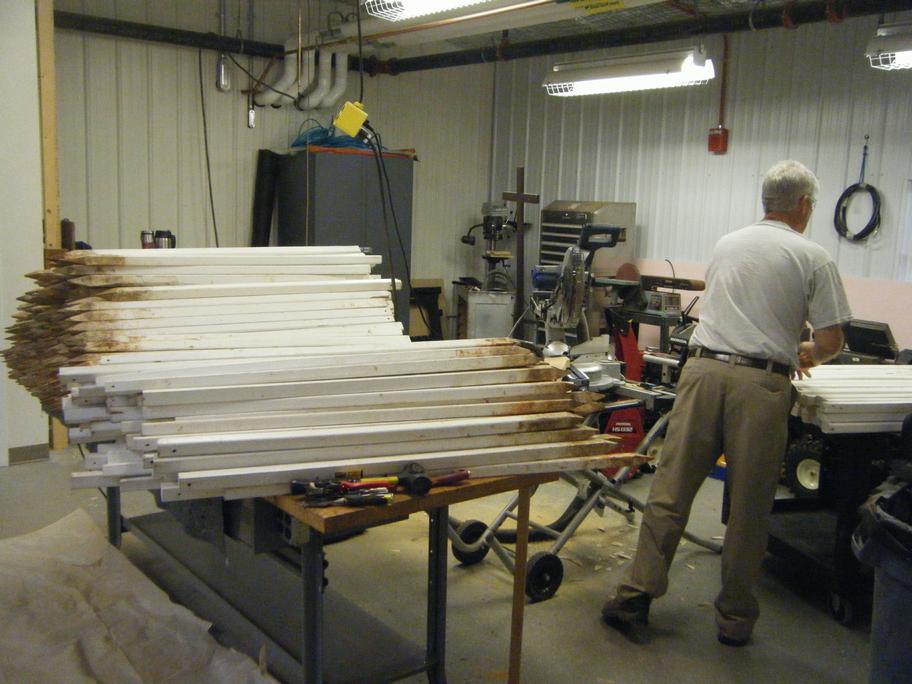

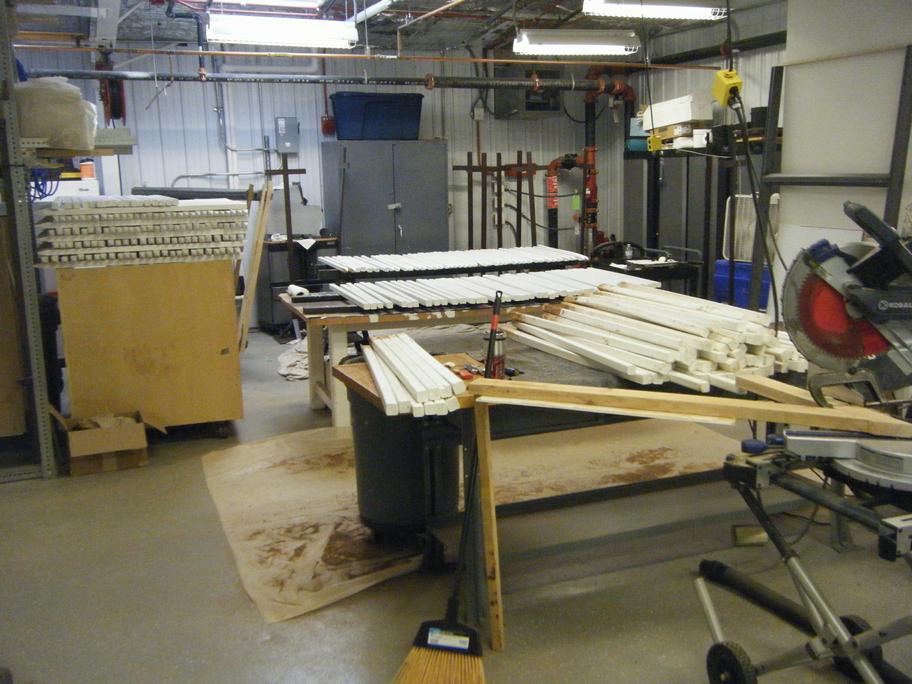

Assemble and deliver "Days On The Lawn" signs to Peabody Hall. (unsched)

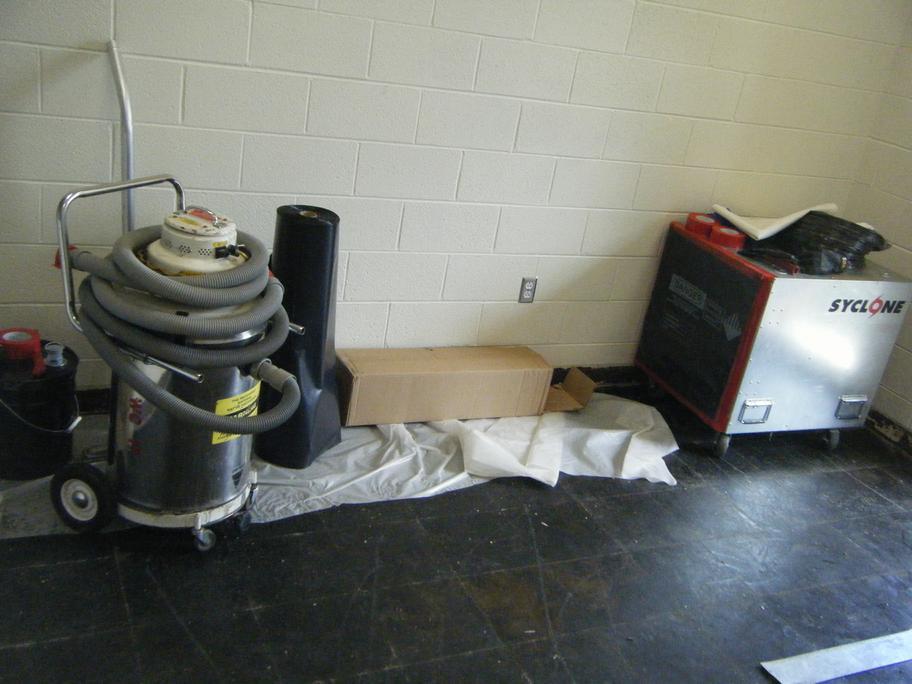

18 Zehmer 118.(service day 2) (3-16 calendar) (3-14 meeting) (3-10 service cancelled) (Sat 2-25 service) (2-2 initial meeting) 19 [PP6b 8 UL. PP6= 64 + 7 OT + 8 Hol + 8 UL + 5 Comp. Leave 158–8=150. Comp 1+5=6. Timesheets]

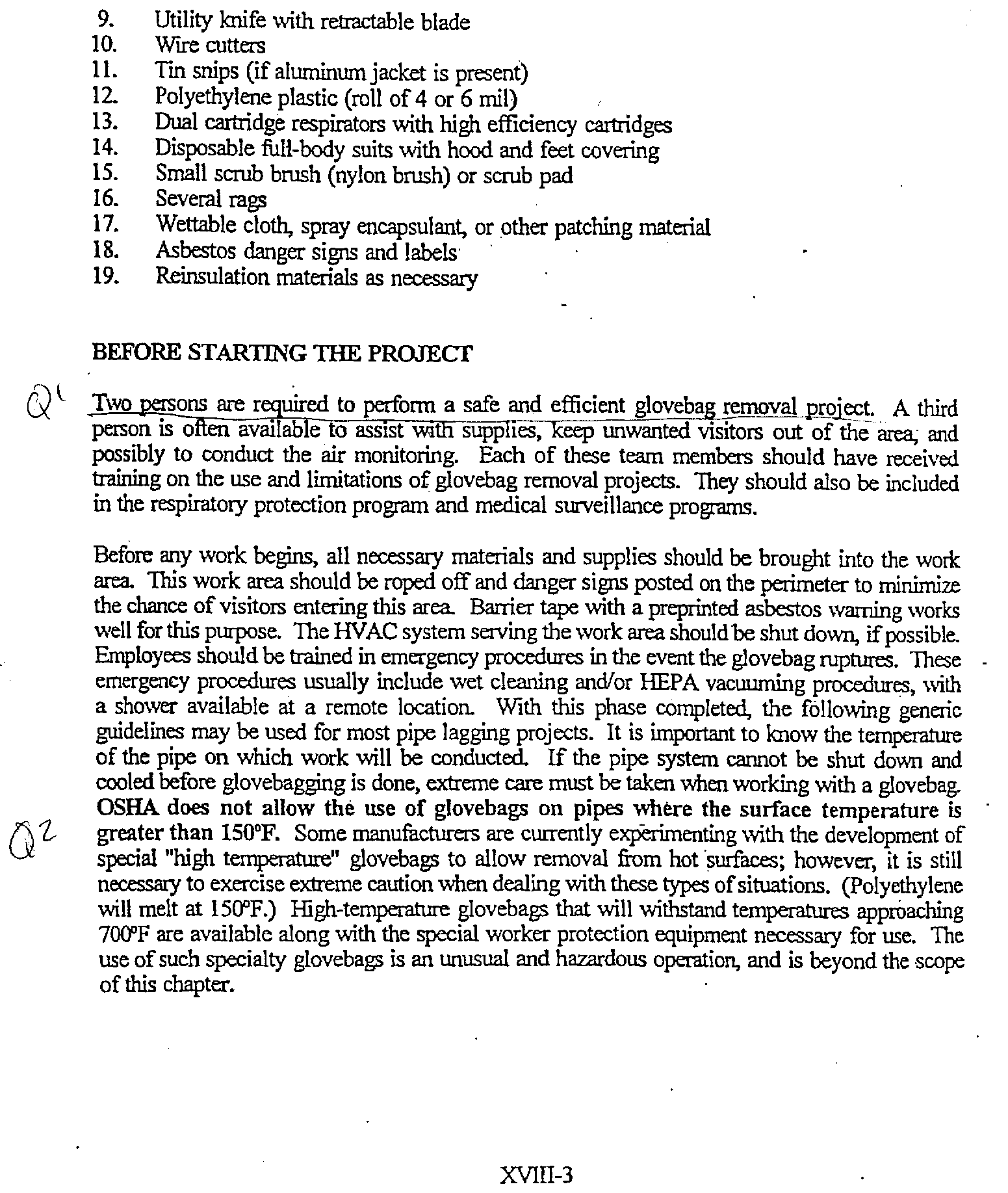

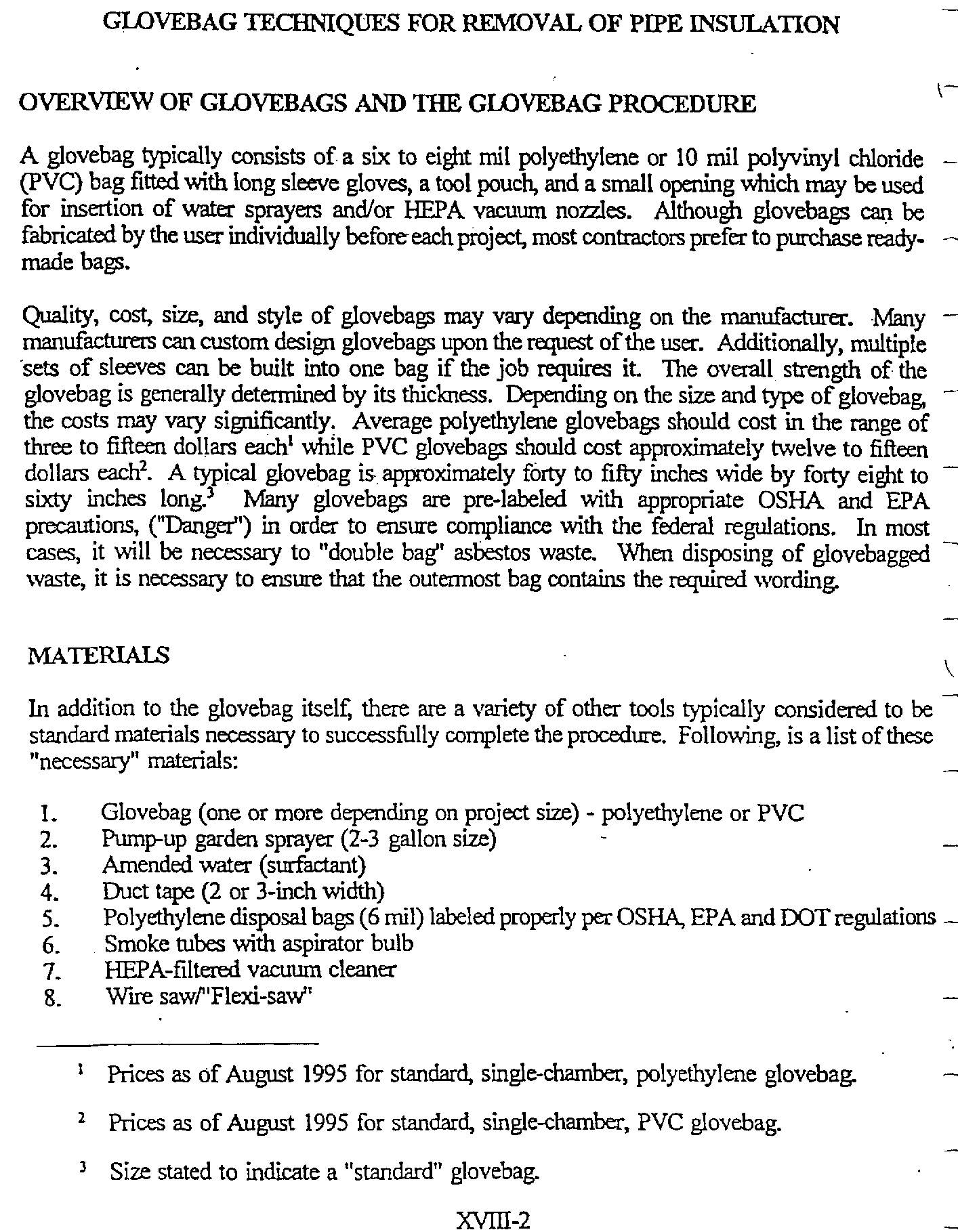

Glovebag Procedure for Pipe Insulation

Billy Method– If glovebag impractical, you still use all the other techniques. Add latex gloves to the routine.

Monday Tuesday Wednesday Thursday Friday Saturday Sunday
20 [8] PP7a Week 74 for unabbreviated view.

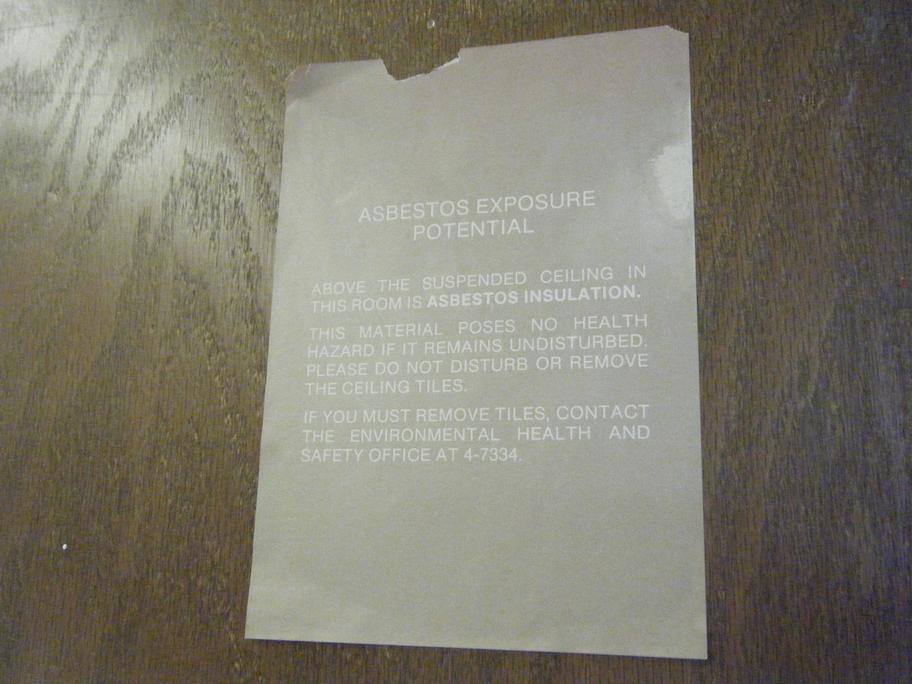

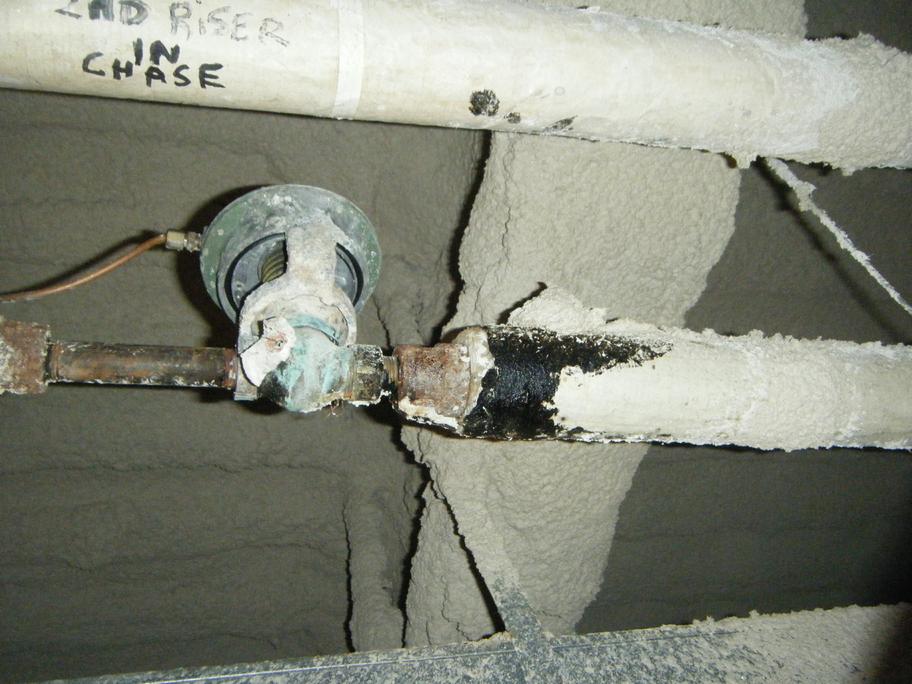

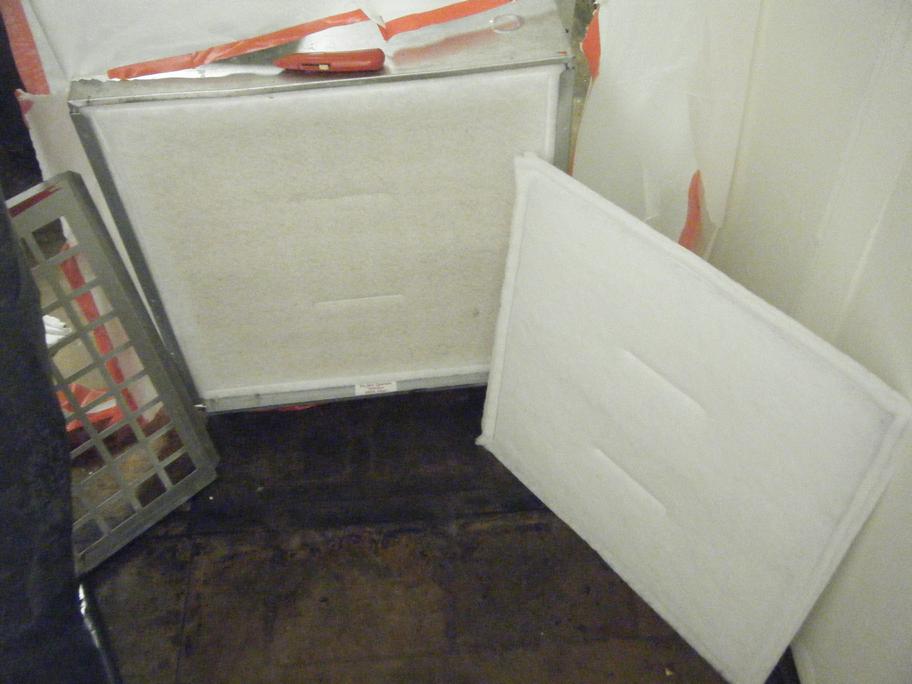

Pinn Hall (Jordan) 2-16. Two locations above drop ceiling. Asbestos & fiberglass insulation. Black Mastic (paint that seals fibers) & Mag (solid asbestos insulation on elbows/joints) are connected by fiberglass.

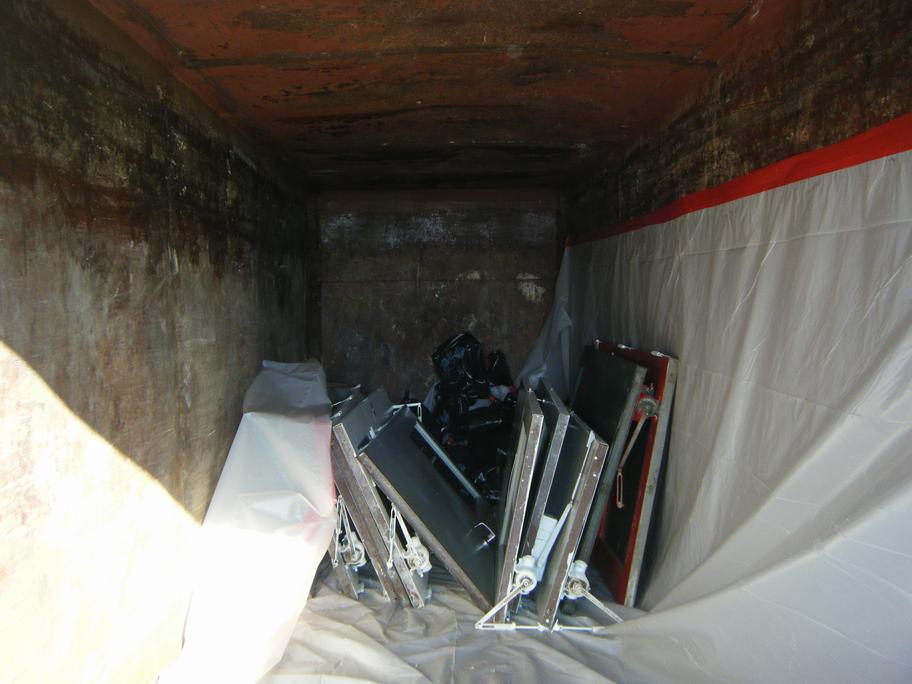

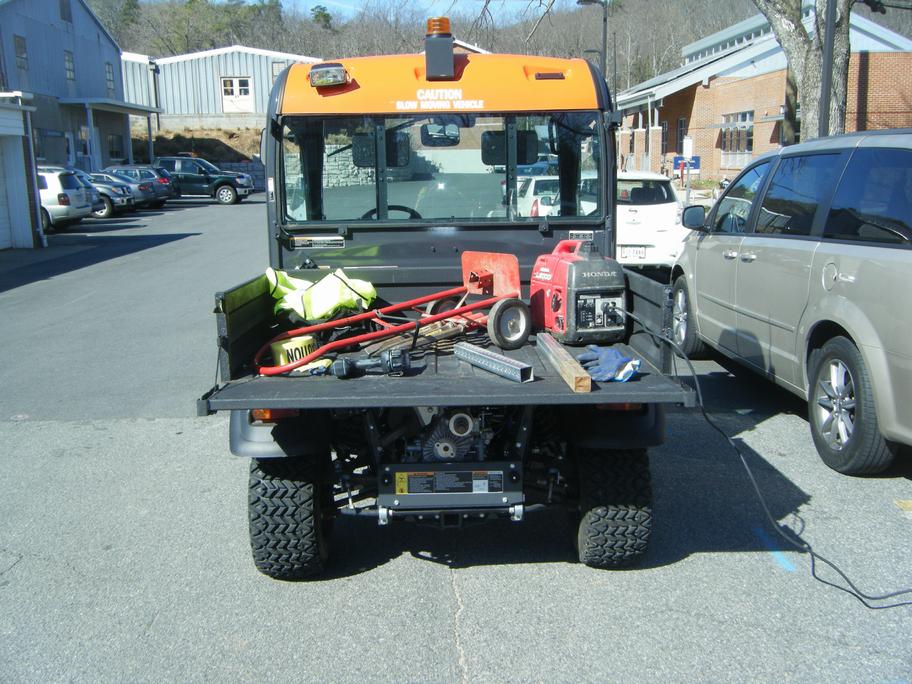

Clean out cargo van to asbestos dumpster. You see the 11 asbestos doors from Fri 3-17.

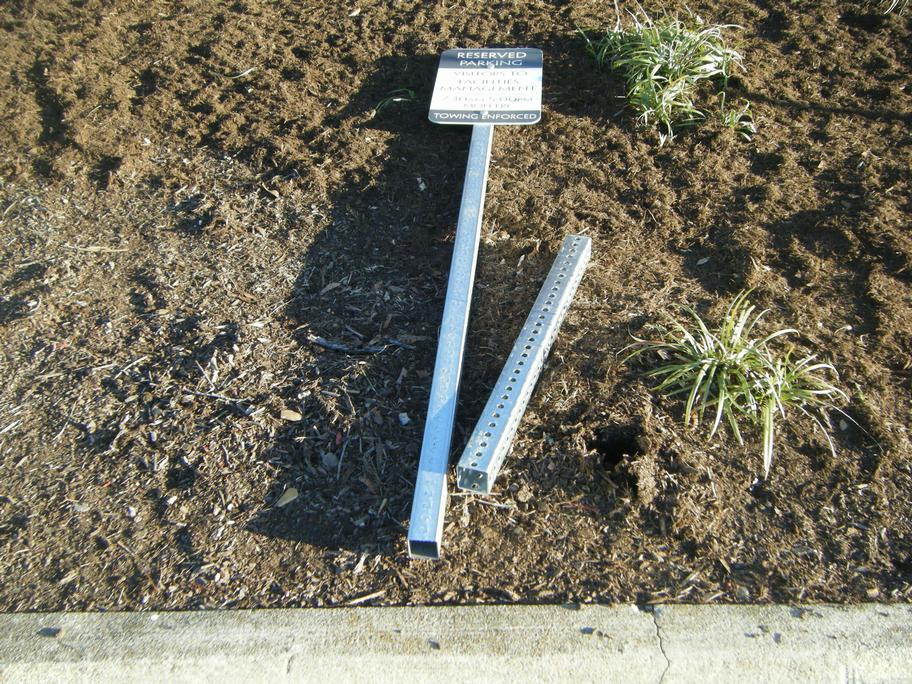

Help install/replace/repair signs at Leake Building, Carruthers, McCormick & Edgemont stop sign. Build frames for large signs. Load snowblowers to be hauled to storage.

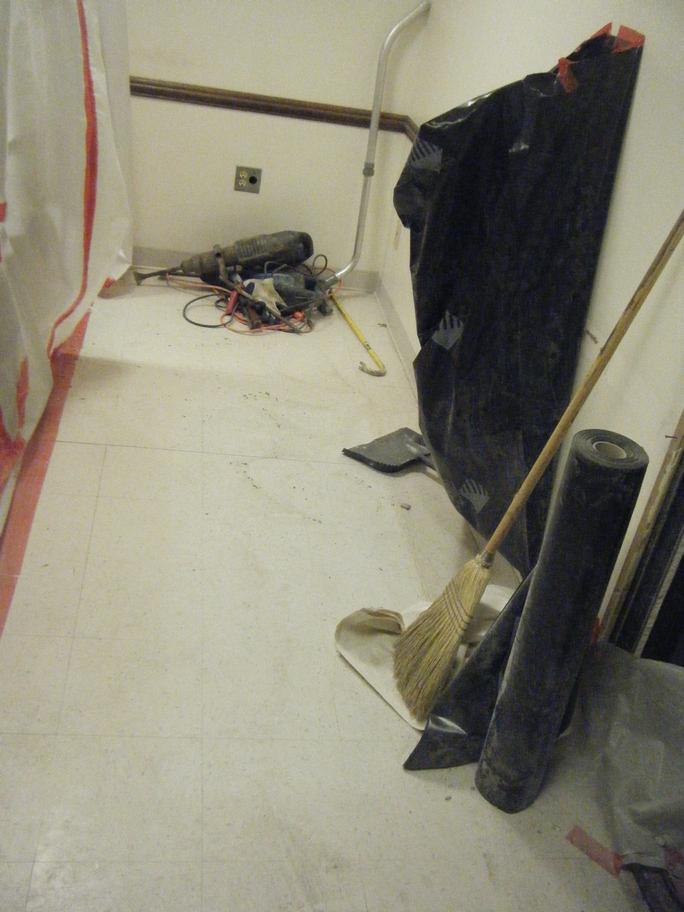

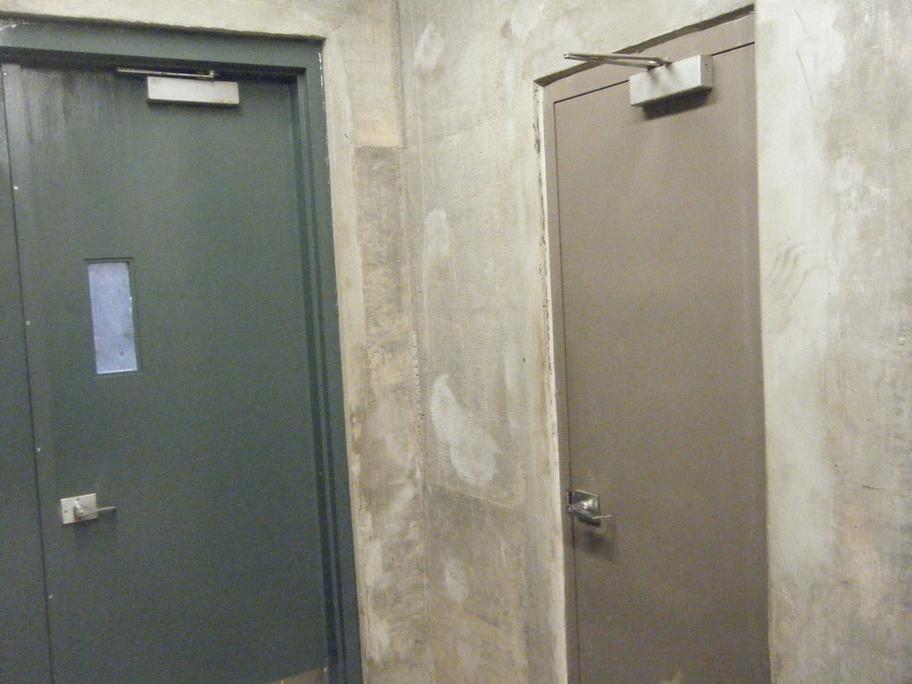

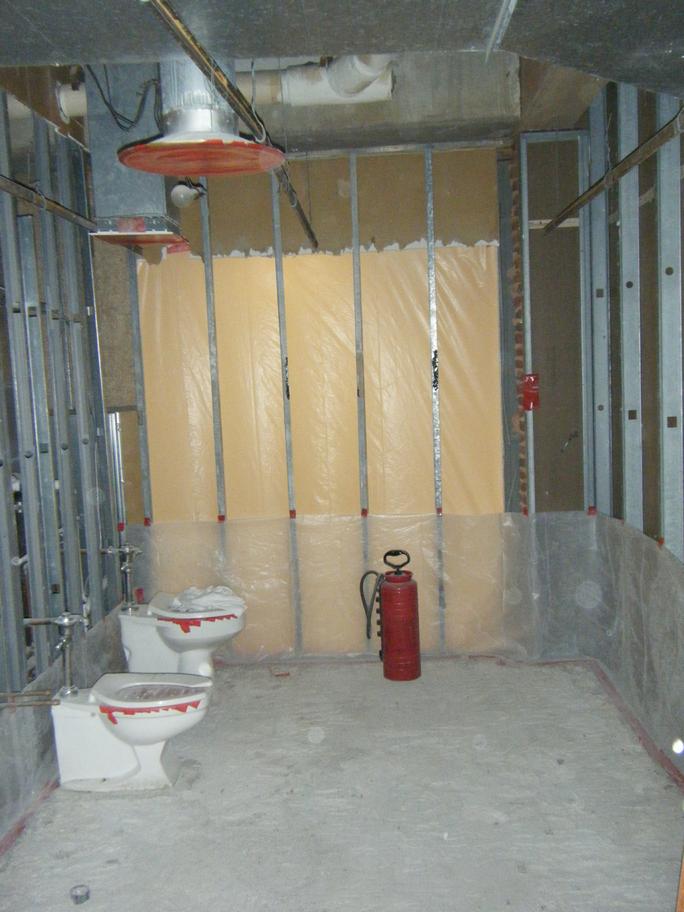

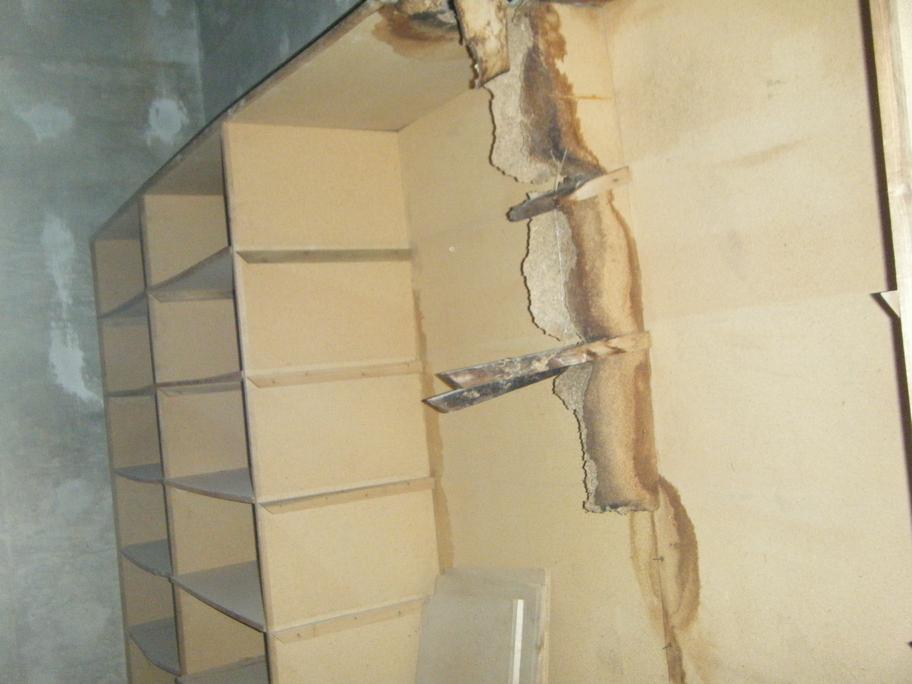

21 [8] Slaughter Hall mildew water damage demolition (2 hours). Day 1.

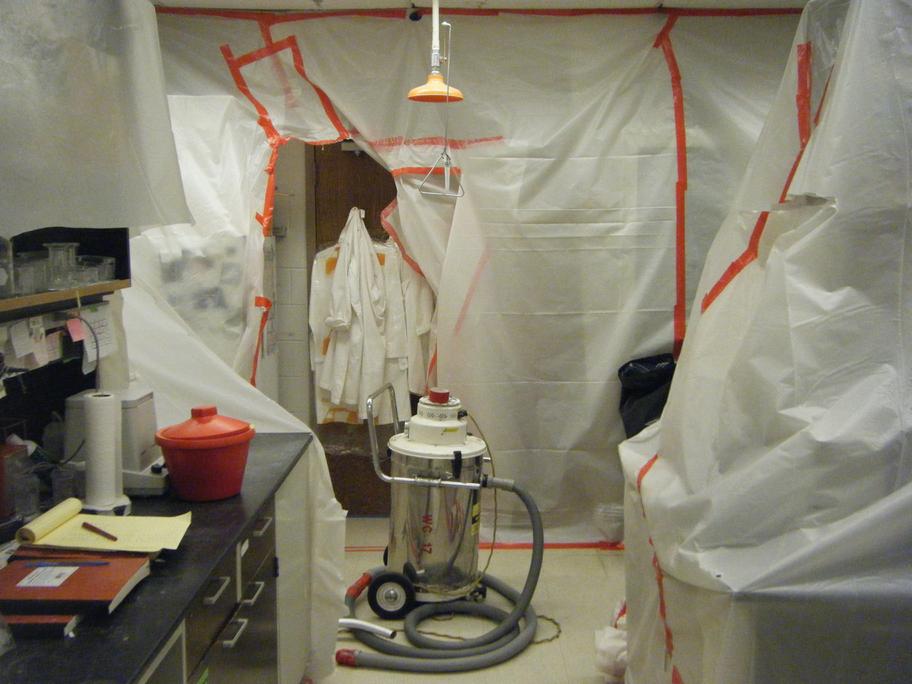

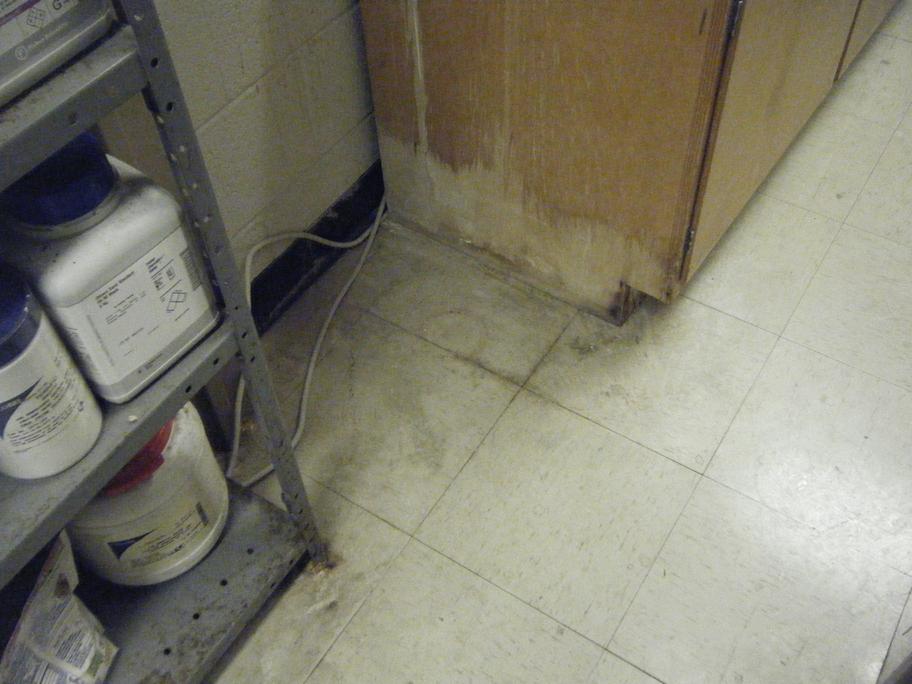

Alderman Library 1st floor kitchen utility room (6 hours). Day 2. Final 4 glovebags removed from Friday. Complete. (15 photos)

22 [8] (Slaughter Hall mildew water damage demolition.) (3-22 off calendar)(3-21 calendar 3-22)

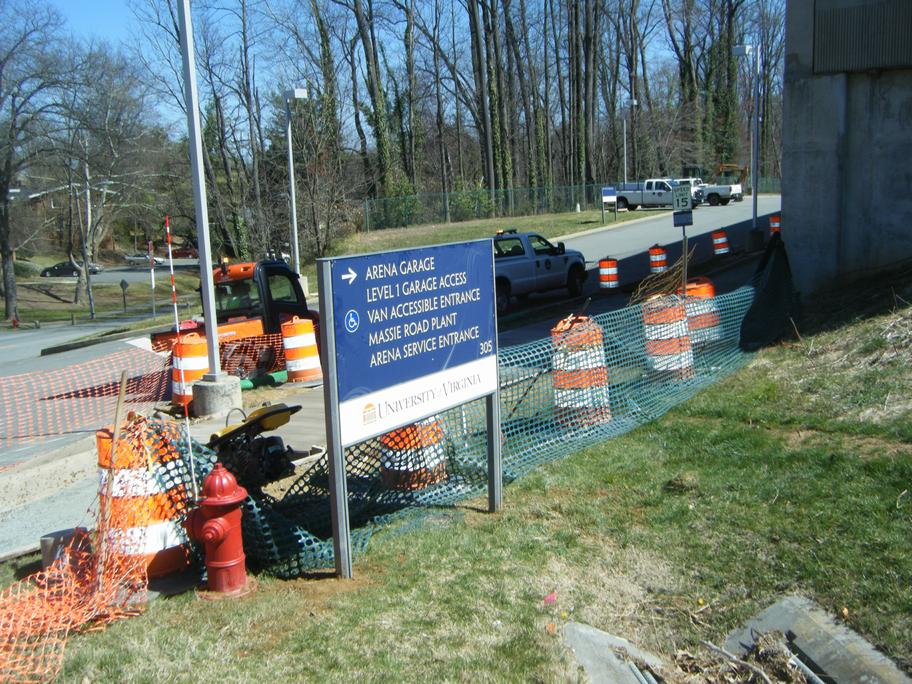

Install/ repair/ replace various signs(8 hours). 3 Valet spaces Medical Center garage. Adjust shuttle banner. Paint blue the scratches on Hospital sign. 3 Reserved Parking at main heating plant hospital west. Retrieve Northridge sign around back at dumpster. Install John Paul Jones arena garage sign and move stop sign. Haul trash to dumpster. (12 photos)

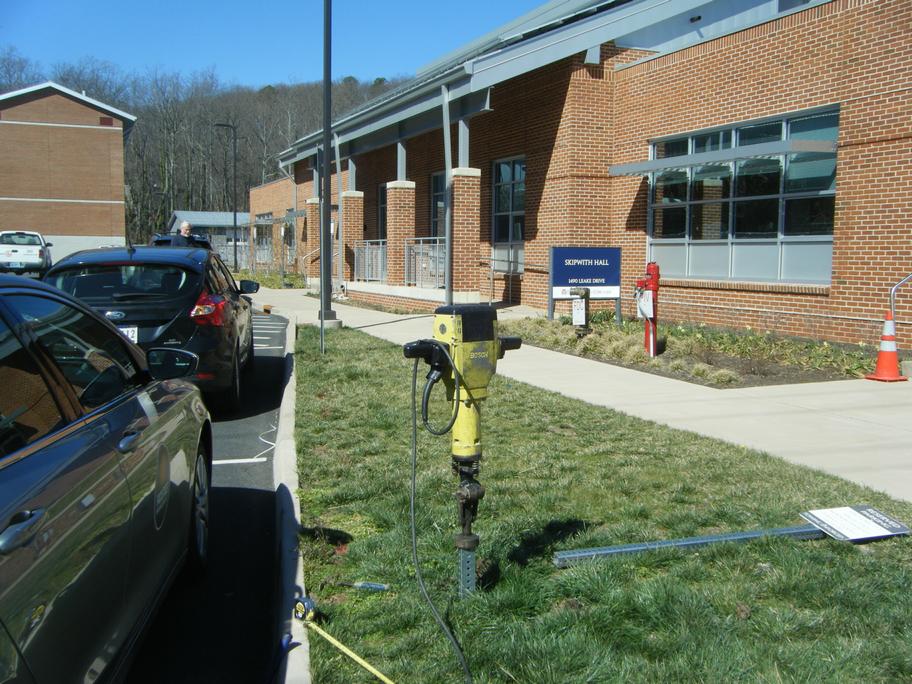

23 [8] Install/ repair/ replace various signs(8 hours). Upper level Leake and Skipwith. Carruthers. (9 photos)
24 [8+2] Payday PP6.

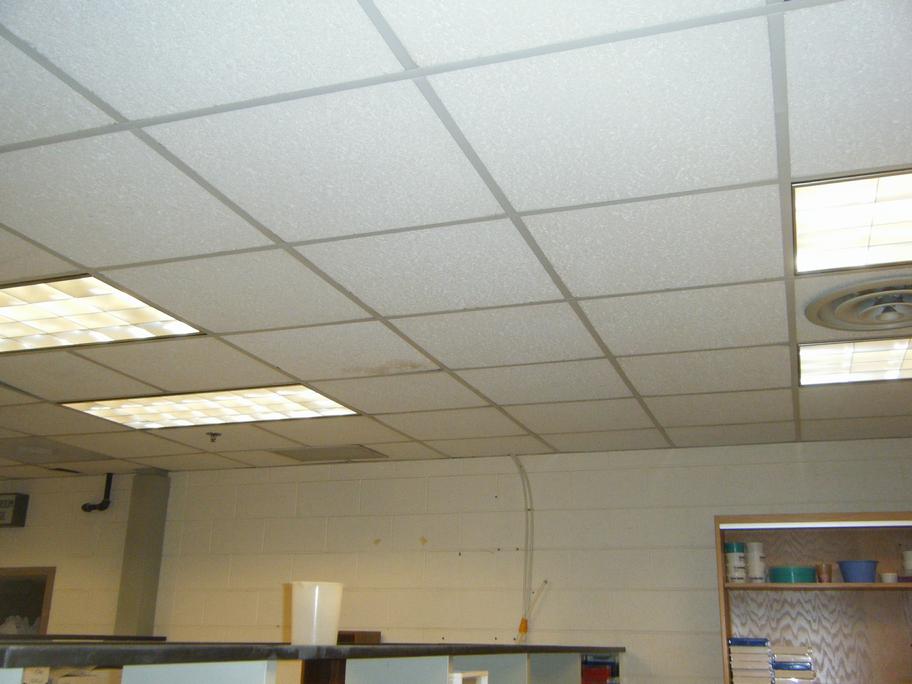

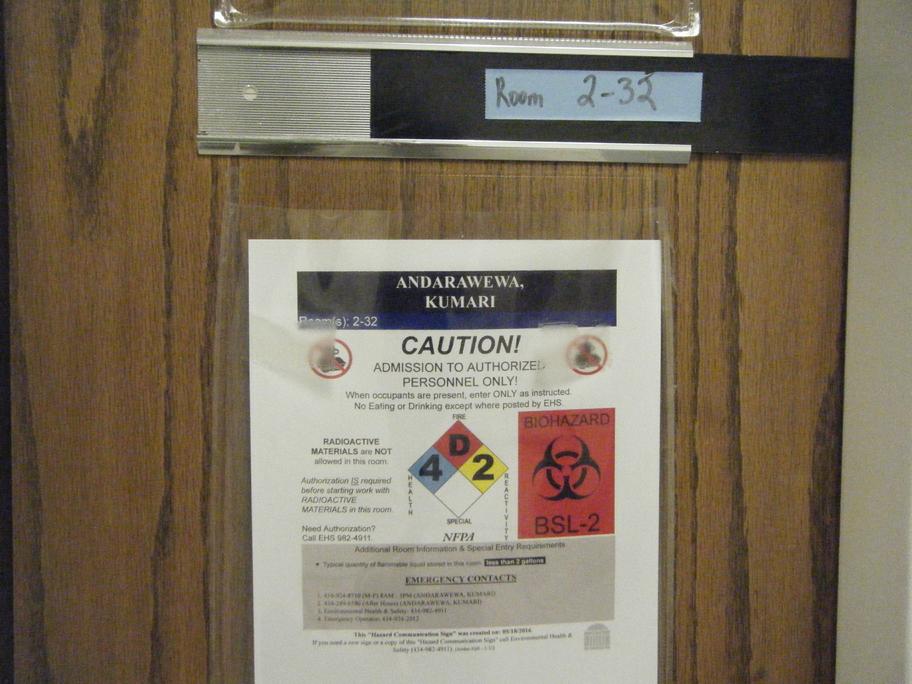

Pinn Hall 2-32 asbestos black mastic elbows above drop ceiling. Complete.

Kerchof asbestos floor tile mastic 4 rooms(306, 304 shown). (10 photos) See Off Calendar.

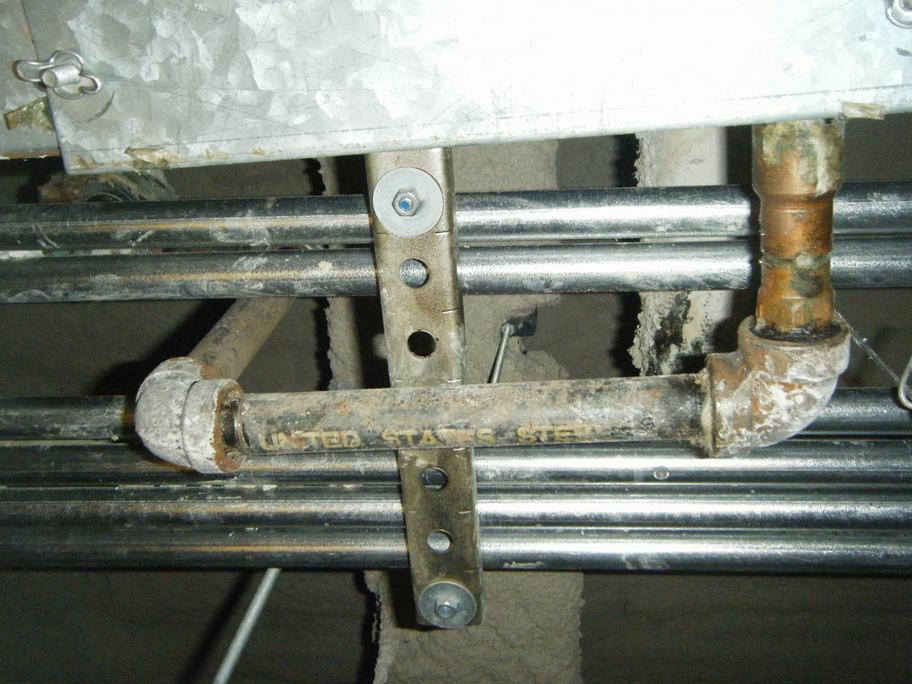

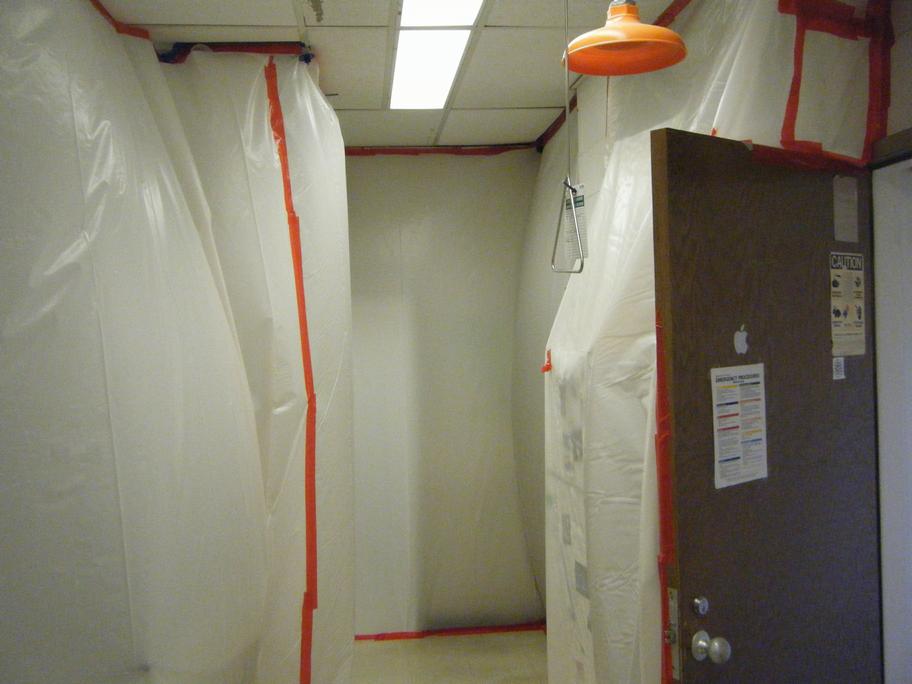

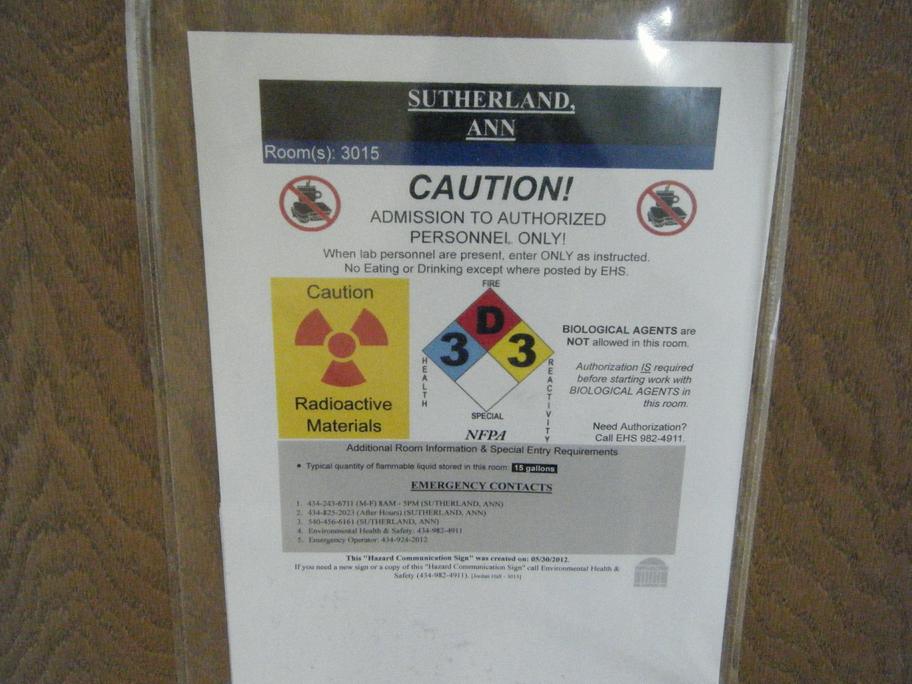

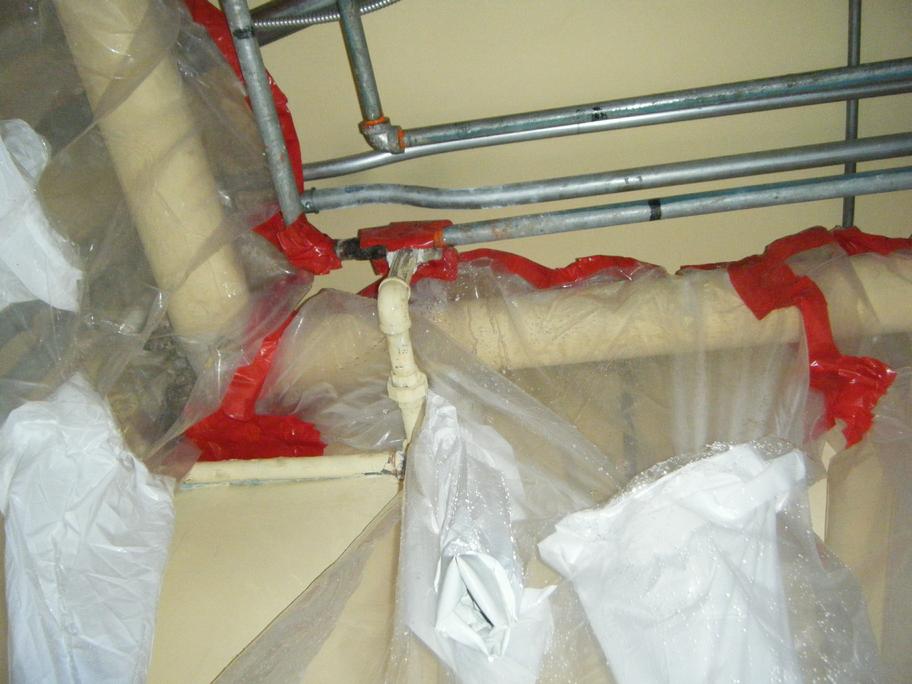

Pinn (Jordan) Hall partial containment for plumbers. Room 3-15 plastic barriers for work above entire drop ceiling where the asbestos is located. To install 40 feet of pipe and 2 core drills into 4th floor through the asbestos. Previously on Fri/Sat 11-18/19-2016 and several days/rooms Mon 10-5-2015.

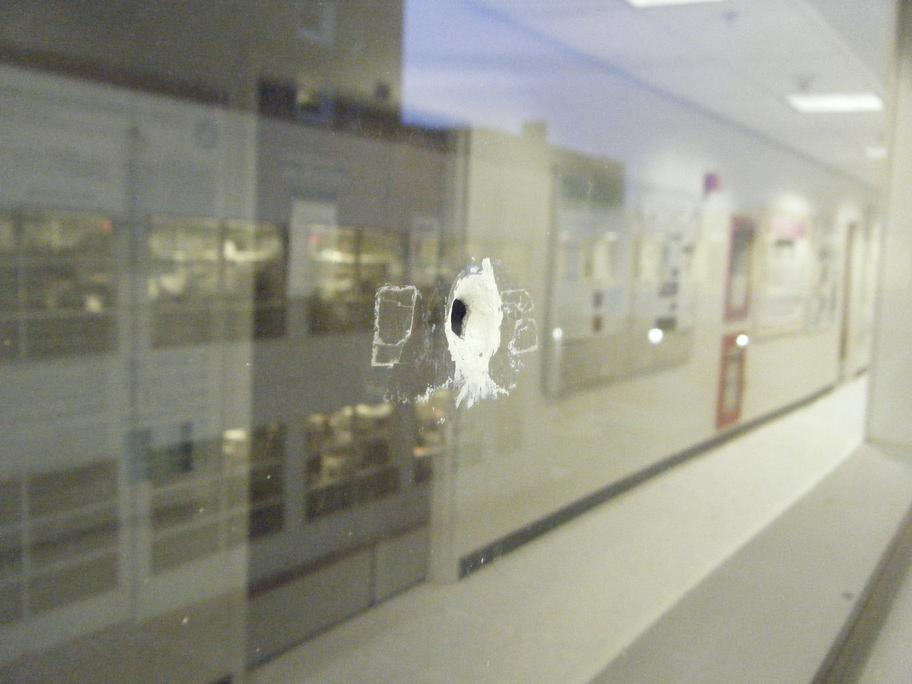

Another problem with Safety Department. Claims that yesterday between 12:30 and 2:00 p.m. a Decibel Noise Recorder in sheet metal shop was tampered with, batteries removed and replaced, and hastily reassembled. So today was a meeting and new policy that doors must be locked at all times. [...] For summary of past problems with Safety Department, click the Weekly View first link every Monday.

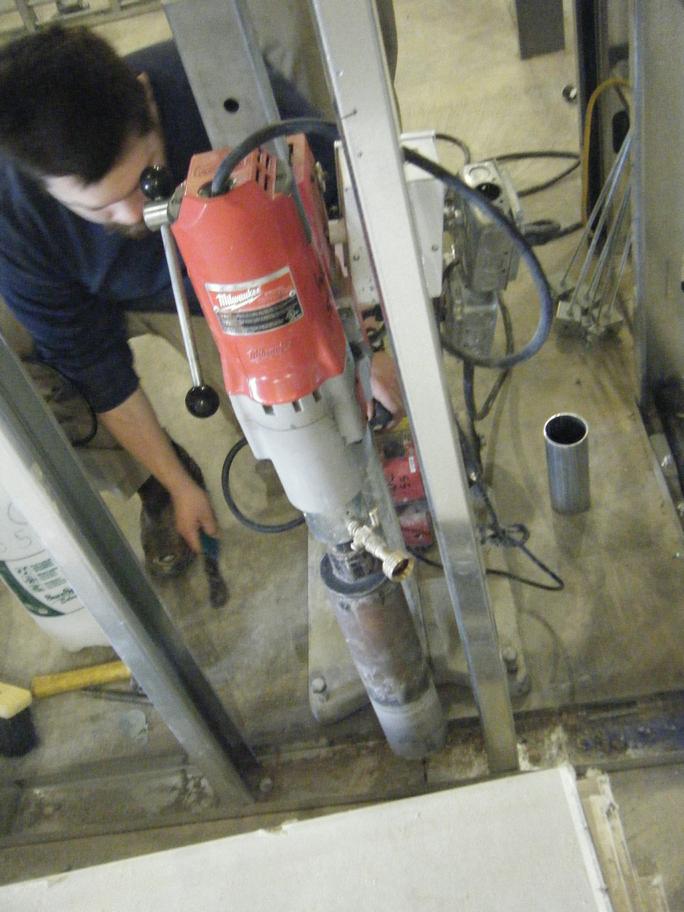

25 [5] 6 a.m. Pinn (Jordan) Hall partial containment for plumbers. Work day 1. (Fri 3-24 meeting) (Tue 3-21 calendar Sat 3-25) (Thu 3-16 calendar Sat 4-1)
26 [3.5] [PP7a= 40 + 10.5 OT(1.5)] Timesheets.

7:30 a.m. (6 a.m. Pinn (Jordan) Hall partial containment for plumbers. Take down plastic and clean up.) Day 2. Everything in cargo van. (11 photos)

Monday Tuesday Wednesday Thursday Friday Saturday Sunday
27 [8] PP7b Week 75

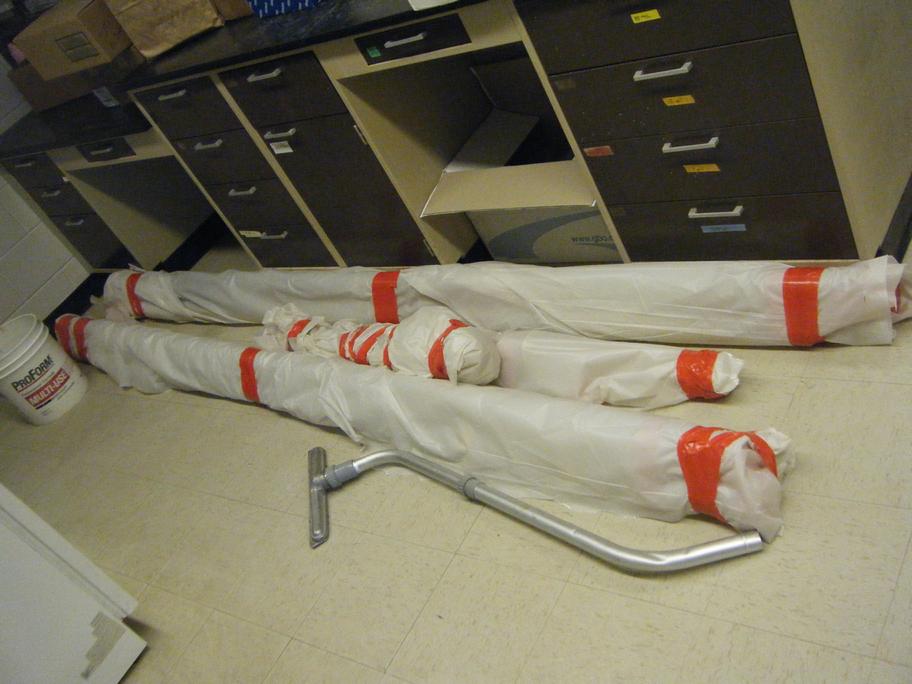

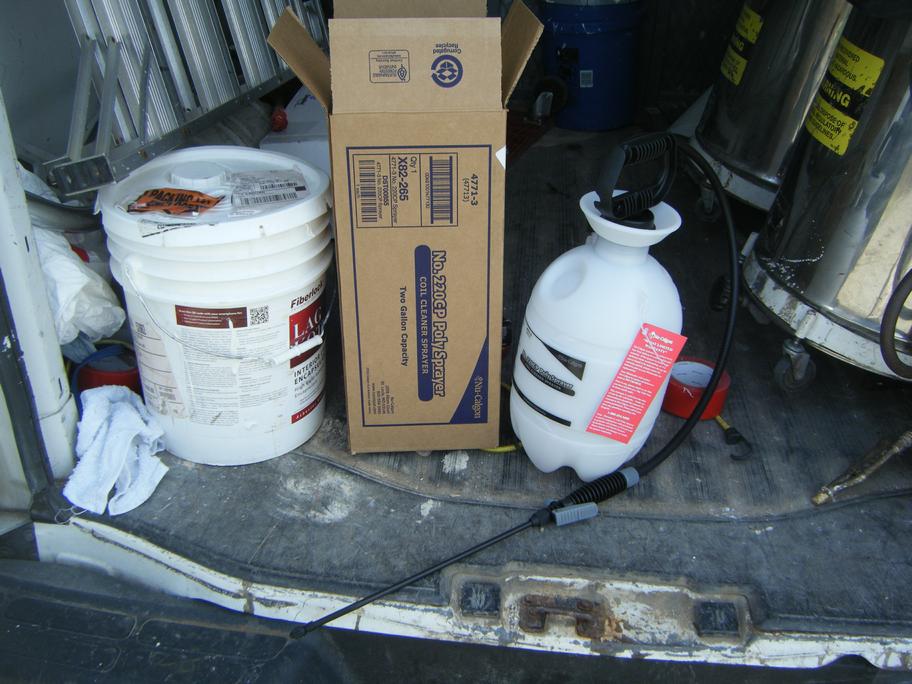

Pinn (Jordan) Hall partial containment for plumbers. Day 3. Unload cargo van to asbestos dumpster.

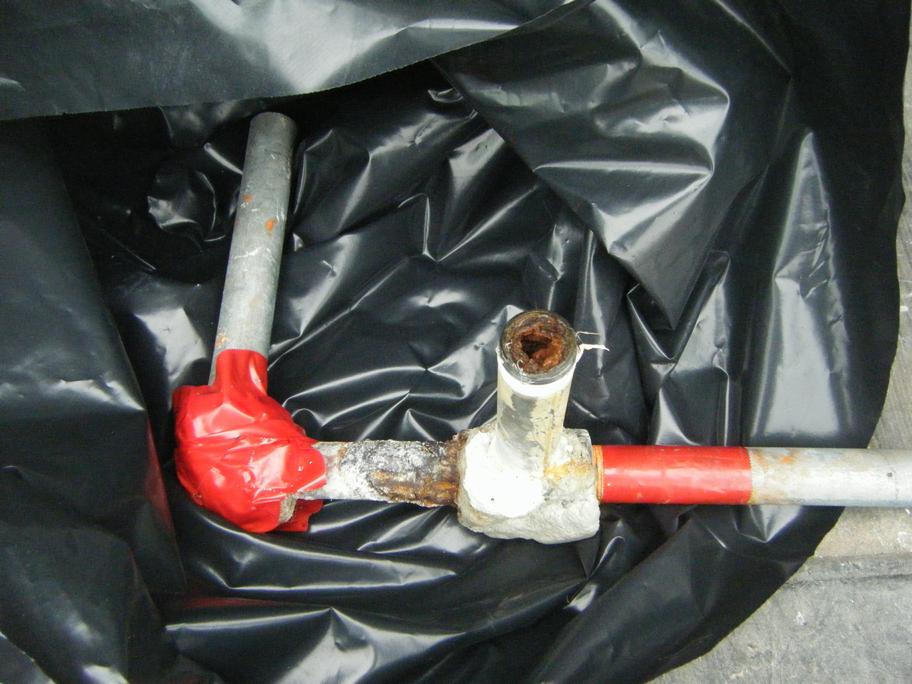

Slaughter Hall mildew water damage demolition. Unload cargo van to construction dumpster. (service day 2) (3-22 off calendar) (3-21 calendar 3-22) (Tue 3-21 Day One 2 hours)
(8 photos)

28 [] Sick Day.

(Slaughter Hall mildew water damage demolition.)(zero)

29 [8] Slaughter Hall mildew water damage demolition. 3 loads cargo van to construction dumpster. Day 3. (12 photos)
30 [8] Slaughter Hall mildew water damage demolition. Day 3 Complete. Haul away equipment. Clean cargo van of sawdust debris still in crevices.

Clark sidewalk steam tunnel asbestos repair for summer wall reinforcement. Day 1. Unprepared. Air gas monitors not charged because there was no notice.

(3-30 comment) I am not the actual supervisor so I'm often the last to know, which makes it hard to prepare. Some of my statements sound fine from a manager, but sound like challenge to authority from labor trying to advance to project manager. Planning the future is harder than logging daily activity. I will always archive this work journal as a role model to show how to break through the stigma of your current job.

31 [8] Possible Heating Plant glovebag asbestos pipe insulation(2 hours). Heating plant vivarium steam tunnel. 2 sets 2 glovebags for asbestos pipe insulation. Need temperature shutdown, measured 209°F infra-red gun. Glovebag melts at 150°F. Crew safety considerateration for extended exposure to elevated temperatures. (3-31 off calendar) (3-30 calendar)

Glovebag of unknown scope and location. Wahoo West Cafe hallway at arched connector to McKim. 2 glovebags for 5 feet asbestos pipe insulation from bare pipe to fiberglass elbow. (3-30 calendar)

Install/ repair/ replace various signs at Medical Center inside and outside (6 hours).

(3-31 comment) New talk that AIM (payroll interface) won't accomodate university-required flexible schedules, won't balance weekdays off with weekend work. Sometimes 40 hours counts as 8 hours overtime and 8 hours leave if your schedule was Tuesday thru Saturday. This only occurs because management over-ride the software to make the schedule fit into non-flexible Mon–Fri format. Timesheets.

(1) [4] 6 a.m. Glovebag of unknown scope and location. Complete.

(3-31) Wahoo West Cafe hallway at arched connector to McKim. 2 glovebags for 5 feet asbestos pipe insulation from bare pipe to fiberglass elbow. (3-30 calendar)

(2) [PP7b= 32 + 8 UL + 4 OT(1) => 36 + 8 UL. PP7= (40 + 10.5 OT(1.5)) + (36 + 8 UL). Leave 150–8= 142. Comp 6.] (see 3-31 comment) Timesheets.

Off Calendar

Possible Heating Plant glovebag asbestos pipe insulation. Heating plant vivarium steam tunnel. 2 sets 2 glovebags for asbestos pipe insulation. Need temperature shutdown, measured 209°F infra-red gun. Glovebag melts at 150°F. Crew safety considerateration for extended exposure to elevated temperatures. (3-31, service 2 hours, off calendar) (3-30 calendar)

JAG 3rd phase 5th floor alumni bar renovation. (Fri 2-3)

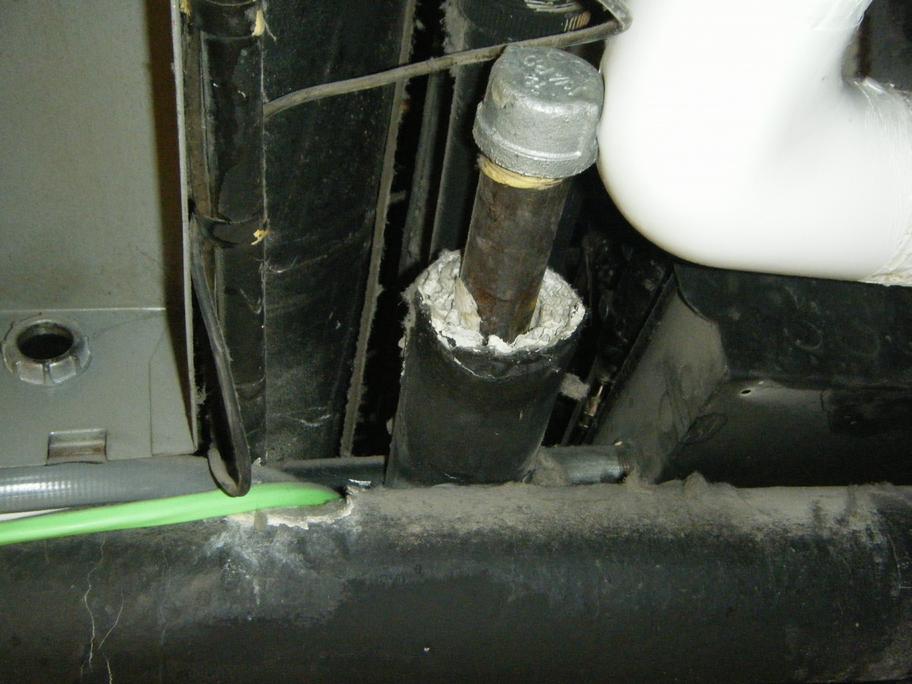

Old Med School 1766A. Asbestos pipe insulation. (Mon 3-13)
(Thu 3-16 Looked at it. Need temperature shutdown measured 177°F. Need schedule when people not in area (4 working).

Kerchof asbestos floor tile mastic 4 rooms(306, 304 shown). 5th room (326) already done. Estimated 7 work-days 3-man crew. Not-to-exceed price estimate. Start window Monday June 5 to early July. (Fri 3-24)

Thu 4-13. 4:00 p.m. Dentist.

Thu 4-20. 8:30–10:00 a.m. Project Services All-Hands Meeting at Zehmer Hall.
