Blair Hawkins' Work Journal

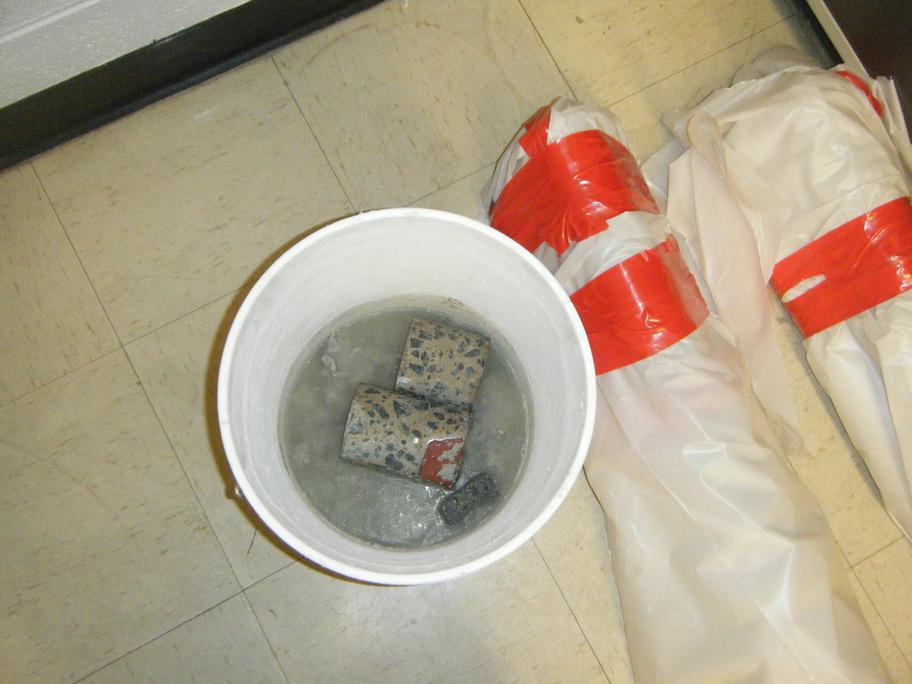

Sun 3-26-2017. Pinn (Jordan) Hall partial containment for plumbers. Day 2. Everything in cargo van.
Sat 3-25-2017. Pinn (Jordan) Hall partial containment for plumbers. Room 3-15 plastic barriers for work above entire drop ceiling where the asbestos is located. Day 1. (3-24 meeting)
Fri 3-24-2017. Pinn Hall 2-32 asbestos black mastic elbows above drop ceiling. Complete.
Kerchof asbestos floor tile mastic 4 rooms(306, 304 shown). 5th room (326) already done. Estimated 7 work-days 3-man crew. Not-to-exceed price estimate. Start window Monday June 5 to early July.

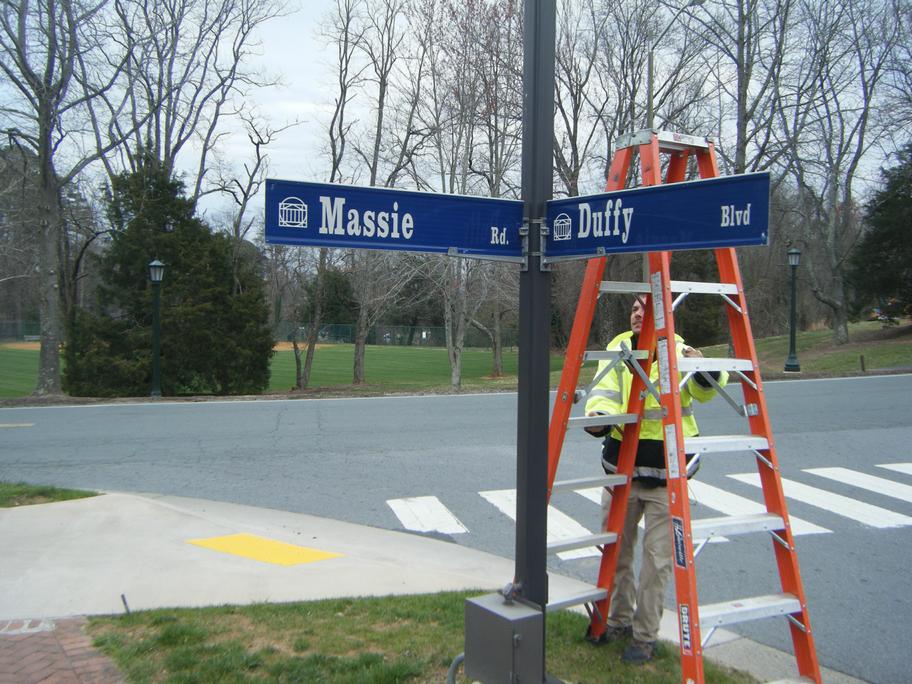

Install/replace/repair signs at Hospital West, Massie & Duffy, Fontaine & Mimosa.
Pinn (Jordan) Hall partial containment for plumbers. Room 3-15 plastic barriers for work above entire drop ceiling where the asbestos is located. To install 40 feet of pipe and 2 core drills into 4th floor through the asbestos. Previously on Fri/Sat 11-18/19-2016 and several days/rooms Mon 10-5-2015.
Another problem with Safety Department. Claims that yesterday between 12:30 and 2:00 p.m. a Decibel Noise Recorder in sheet metal shop was tampered with, batteries removed and replaced, and hastily reassembled. So today was a meeting and new policy that doors must be locked at all times. I'm not quick to believe the accuser. The Safety Department itself has tampered with my Air Gas Monitor (Mon 6-27-2016) by not documenting service and chain of custody. More recently Safety was unable to find a USB infra-red reader for the Air Gas Monitor in order to perform service. (Fri 1-13-2017) Safety said they asked the plumbers, who have the calibration station. Later the plumbers told me they do have the USB reader. The specialized Asbestos Safety Inspectors have also come under scrutiny for creating the appearance that all air samples are negative for asbestos and not actually analyzed under the microscope. The first tip-off was the documentation stopped coming. After telling the Director, some exposure sheets were delivered to asbestos department. But not the current year. So back to the Director. More sheets came. Since then there are very few personal air samples taken. With the data dump, I was finally able on 10-22-2015 to "close out" a job from 9-24-2014 where horse hair turned out to be 90% amosite asbestos. The attitude of the inspector was another tip-off summarized 11-12-2015 Week 7.
Thu 3-23-2017. Install/repair/replace various signs(8 hours). Upper level Leake and Skipwith. Carruthers.

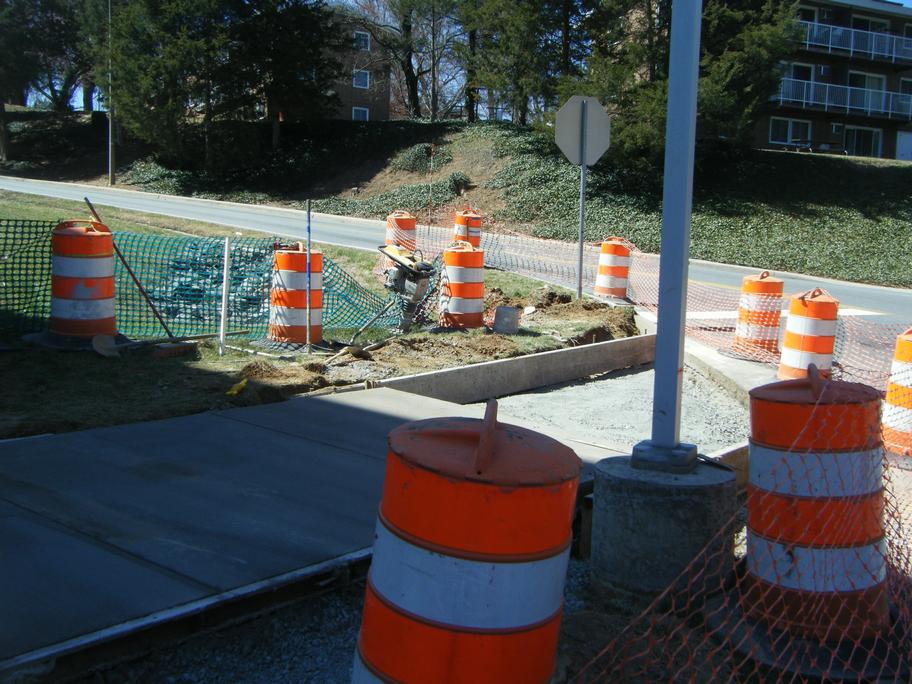

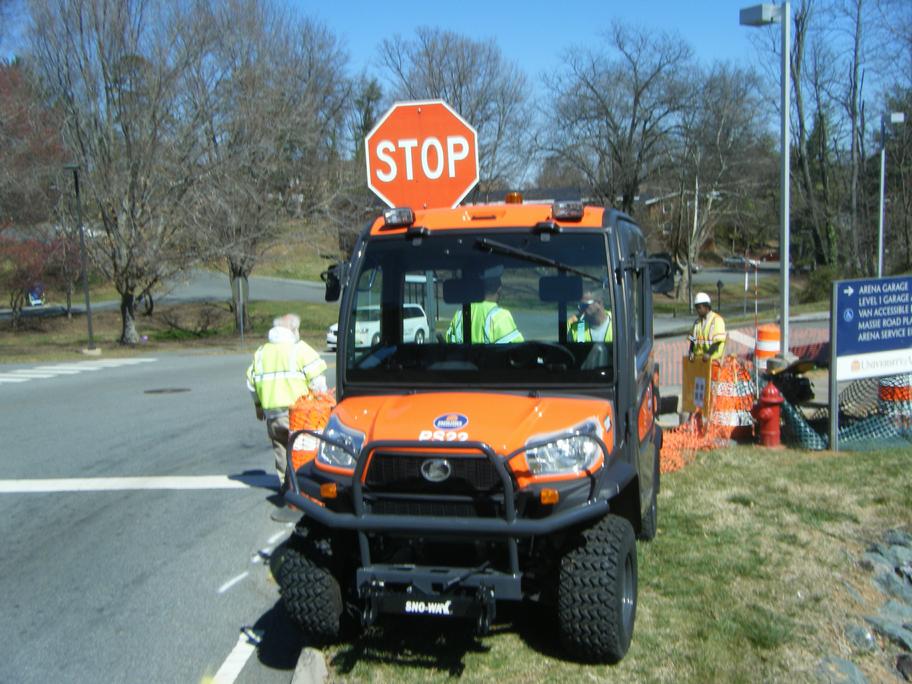

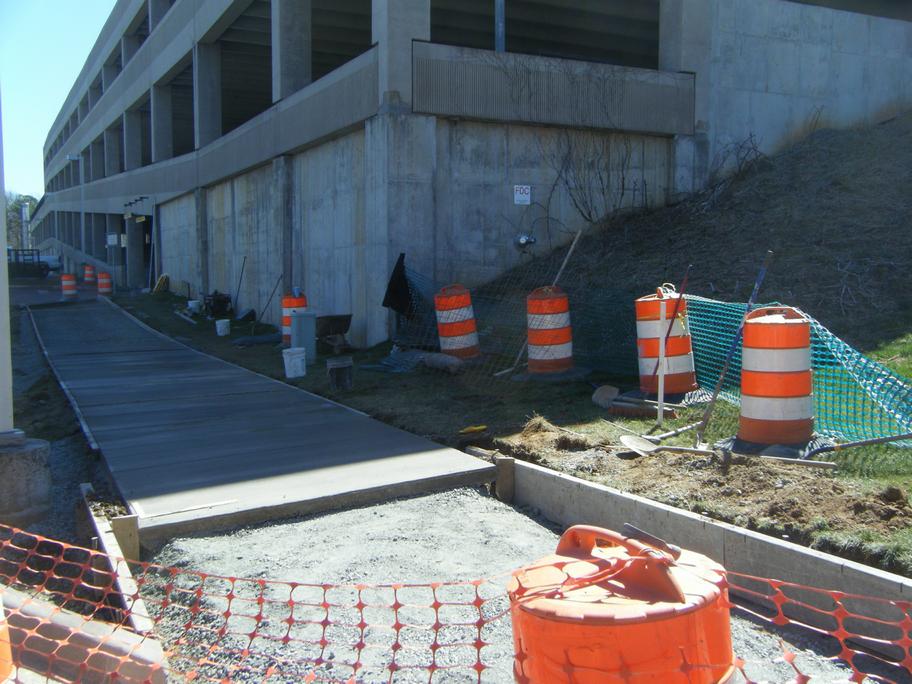

Wed 3-22-2017. Install/repair/replace various signs(8 hours). 3 Valet spaces Medical Center garage. Adjust shuttle banner. Paint blue the scratches on Hospital sign. 3 Reserved Parking at main heating plant hospital west. Retrieve Northridge sign around back at dumpster. Install John Paul Jones arena garage sign and move stop sign. Haul trash to dumpster.

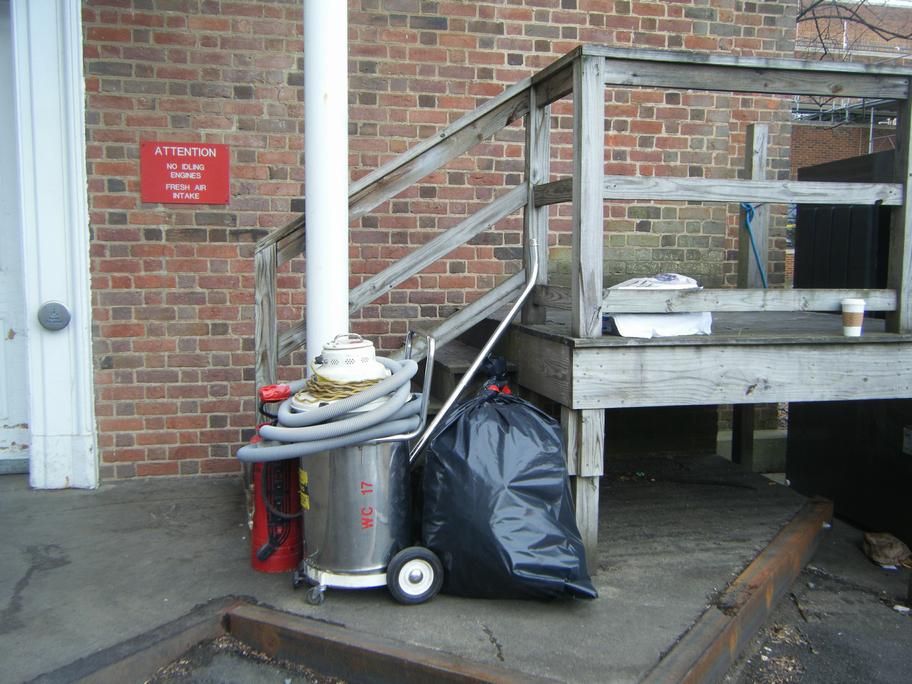

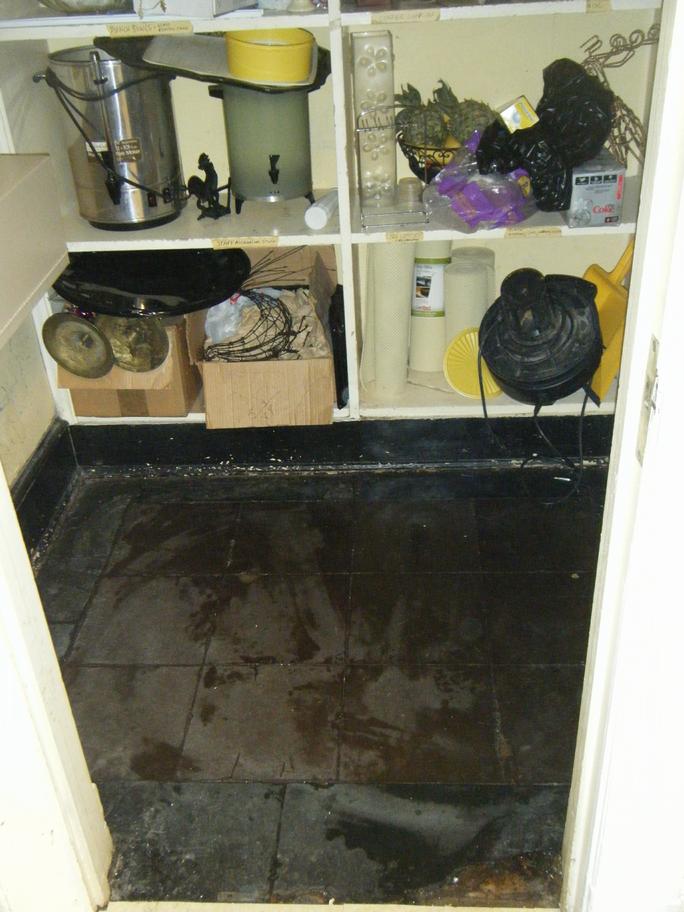

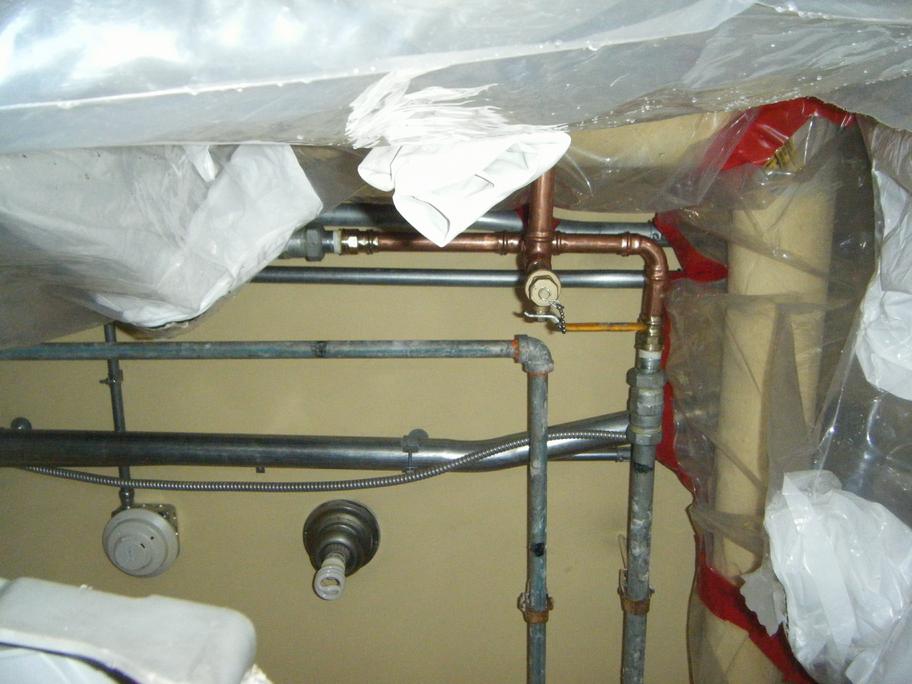

Tue 3-21-2017. Slaughter Hall mildew water damage demolition (2 hours). Day 1.

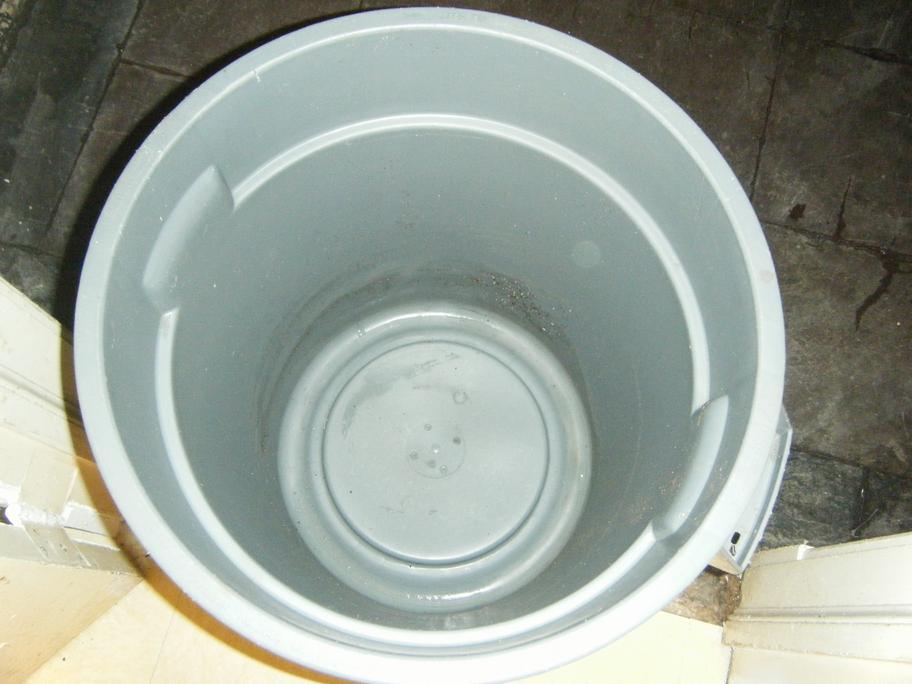

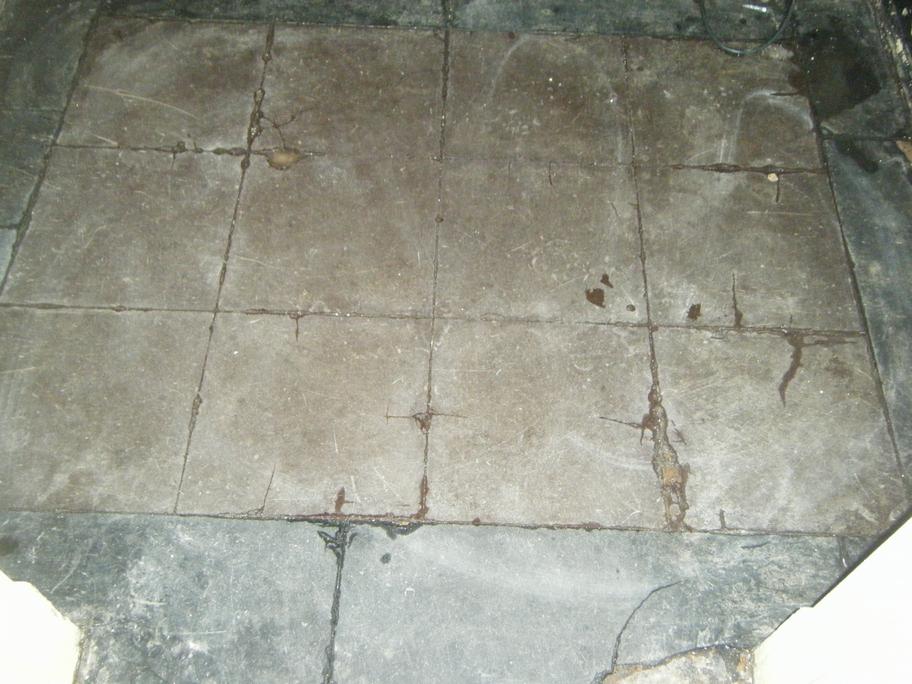

Alderman Library 1st floor kitchen utility room (6 hours). Day 2. Final 4 glovebags removed from Friday. Complete.

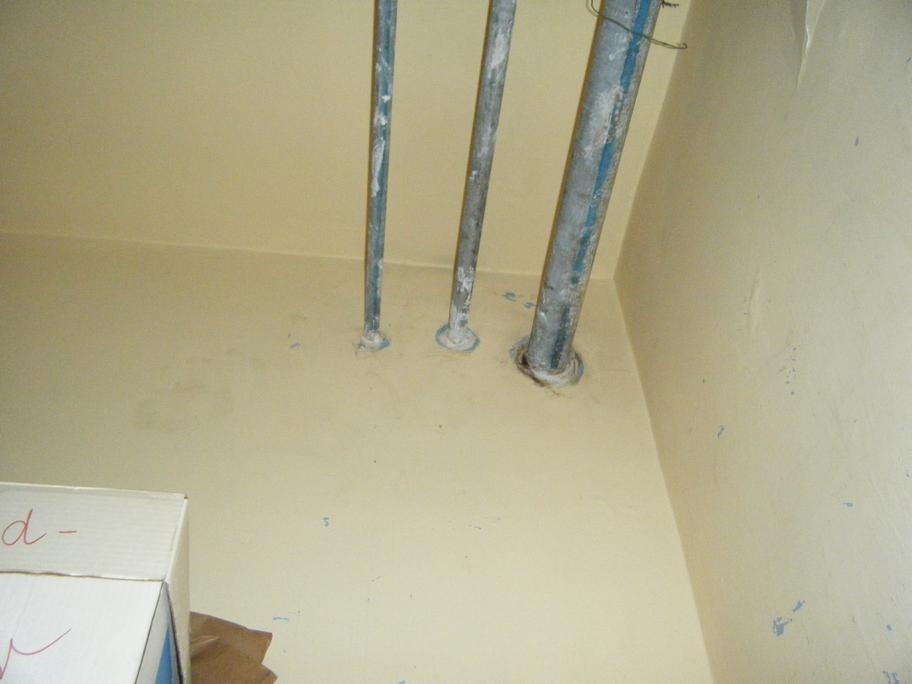

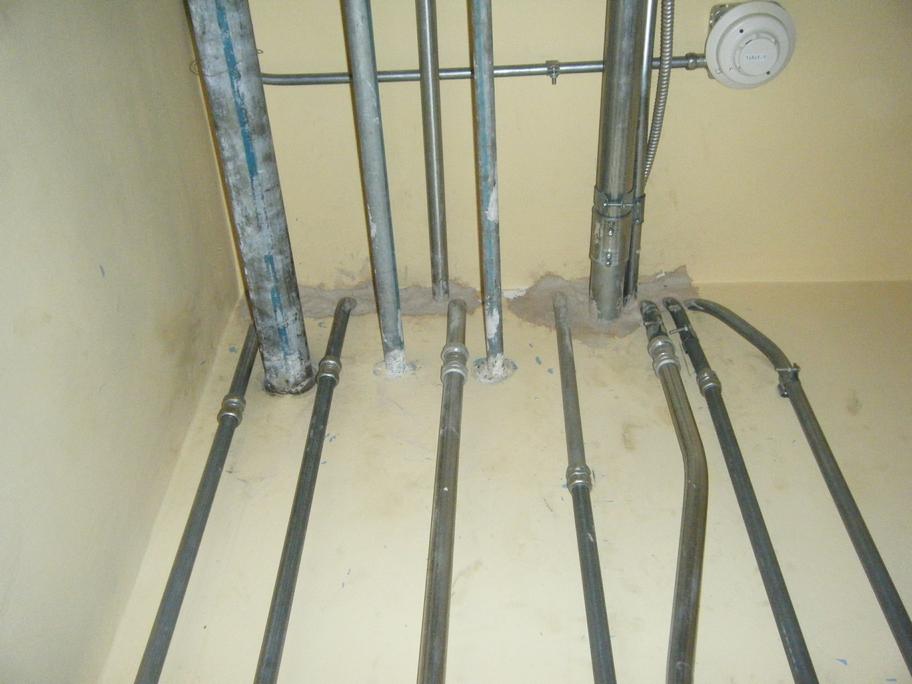

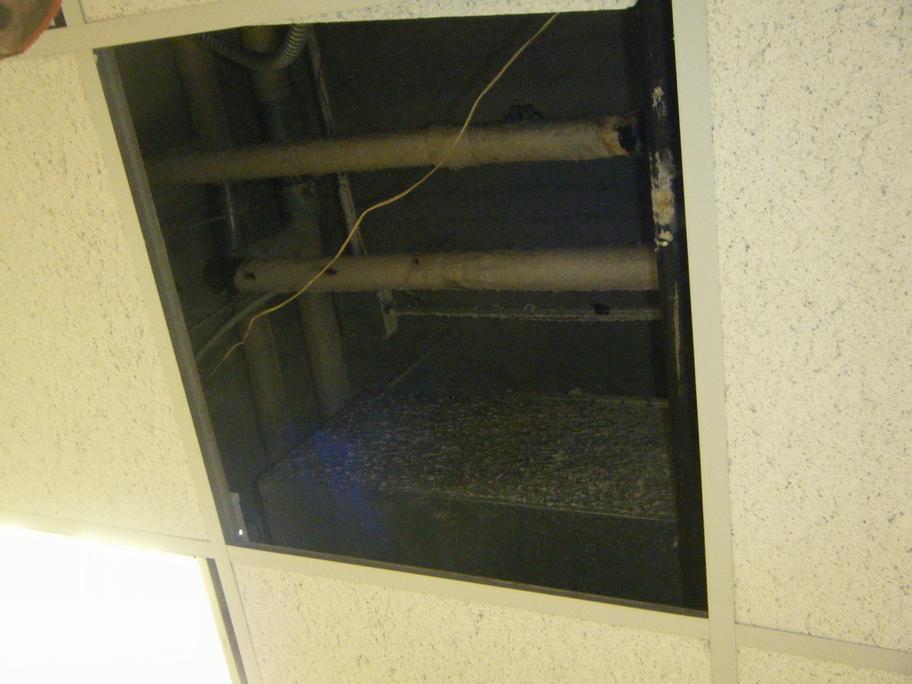

Mon 3-20-2017. Pinn Hall (Jordan) 2-16. Two locations above drop ceiling. Asbestos & fiberglass insulation. Black Mastic (paint on joint/elbow that seals fibers) & Mag (solid asbestos insulation on elbows/joints) are connected by fiberglass.

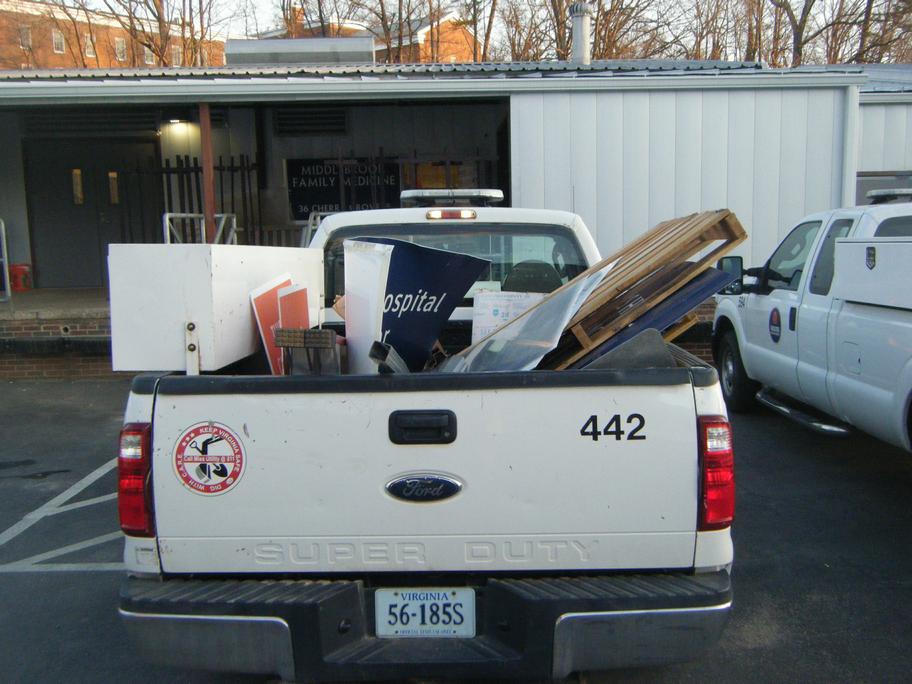

Clean out cargo van to asbestos dumpster. You see the 11 asbestos doors from Fri 3-17.

Help intall/replace/repair signs at Leake Building, Carruthers, McCormick & Edgemont stop sign. Build frames for large signs. Load snowblowers to be hauled to storage.
Payday 4-7. PP7. Leave 150 start. Comp 1. Timesheets.
1st Week Mar 20 || M 8 | T 8 | W 8 | Th 8 | F 8 || Sa 5 | Su 3.5 = 40 + 8.5 OT.
2nd Week Mar 27 || M | T | W | Th | F || Sa|Su =
